Airport Tung Chung Link

Construction Noise Management Plan

5 January 2026

Ref: RT25358-AC-01C

Prepared by:

BeeXergy Consulting Limited (BXG)

in association with

Penta-Ocean Construction Co., Ltd

Project:

AIRPORT TUNG CHUNG LINK (Contract C24W08)

CONSTRUCTION NOISE MANAGEMENT PLAN

Report No.:

RT25358-AC-01B

Revision

Issue Date

Description

Author

Checker

Approver

0

Oct 9, 25

Issued for Comment

Various

WKS

FS

A

Nov 17, 25

Issued for Comment

Various

WKS

FS

B

Dec 12, 25

Issued for Comment

Various

CAH

FS

C

Jan 5, 26

Issued for Comment

Various

CAH

FS

Table of Content

1.            Introduction.. 1

2.            Environmental Legislation.. 1

3.            Noise criteria.. 2

4.            Assessment Methodology.. 2

5.            Construction Programme.. 2

6.            Identification of Noise Sensitive Receivers. 3

7.            Construction Noise Impact Assessment. 3

8.            Good Site Practices. 7

9.            CONCLUSION.. 7

Figure 6.1: Project Location.. 8

Figure 6.2: NSR Location.. 9

Appendix 7.1: CONSTRUCTION Programme.. 10

Appendix 7.2: proposed construction plant inventory.. 11

Appendix 7.3: Construction noise calculations (Unmitigated) 12

Appendix 7.4: catalogue and SECTIONAL drawing of noise barrier.. 13

Appendix 7.5: Construction noise calculations (Mitigated) 14

Appendix 7.6: Implementation Schedule of Proposed Mitigation Measures  15

Appendix 7.7: Extracted CNMP for Tung Chung Line Extension project Submissions under EP-614/2022. 16

1.       Introduction

The EIA Report for Airport Tung Chung Link Project (the ATCL Project) (AEIAR-254/2023) was approved on 26 October 2023. The Environmental Permit (EP) (AEР-630/2023) was issued on 26 October 2023. According to Clause 2.12 of the EP, the Permit Holder shall submit a Construction Noise Management Plan (CNMP) for implementing construction noise mitigation measures no later than 2 months before the commencement of construction works of the Project to the Director of Environmental Protection (DEP).

As stipulated in Clause 2.12 of the EP, 3 hard copies and 1 electronic copy of the CNMP shall, no later than 2 months before the commencement of construction works of the Project, be deposited with the DEP. If there is any change to the construction noise mitigation measures and/or plant inventory recommended in the submitted CNMP, 3 hard copies and 1 electronic copy of an updated CNMP shall, no later than 1 month before the implementation of any such change, be deposited with the DEP. The CNMP and updated CNMP shall identify the noise source inventory and assess the effectiveness of construction noise mitigation measures, including the use of quieter powered mechanical equipment, quieter construction methods, noise barriers, enclosures and insulation fabric as recommended in the approved EIA Report (Register No. AEIAR-254/2023) for mitigating the construction noise impact of the Project. The CNMP and updated CNMP shall include an implementation schedule in table form to clearly list out the mitigation measures to be implemented, and the implementation party, location, timing, and environmental performance required for implementation of the mitigation measures. The CNMP and updated CNMP shall be prepared and checked by a Certified Noise Modelling Professional as recognized by the Hong Kong Institute of Qualified Environmental Professionals Limited or other professional as agreed by the Director, certified by the ET Leader and verified by the IEC as conforming to the relevant information and recommendations of the approved EIA Report (Register No. AEIAR-254/2023). All mitigation measures recommended and requirements specified in the CNMP and the updated CNMP shall be fully implemented.

This CNMP will be regularly reviewed and updated to reflect any changes in construction work or site arrangements, ensuring continuous compliance. This CNMP focused on the construction works conducted during Jan 2026 to May 2026 only and the remaining construction period is still under planning and subject to change. The Contractor will submit other CNMP for the remaining construction period once the details become available. If there is any update on the construction works conducted from Jan 2026 to May 2026, a revised CNMP will be submitted to the EPD.

2.       Environmental Legislation

The Noise Control Ordinance (NCO) (Cap. 400) provides the statutory framework for noise control. The Environmental Impact Assessment Ordinance (EIAO) (Cap. 499) provides the framework for assessment of the noise impact for designated projects

Reference to the EIAO and the relevant technical memoranda has been made for the assessment of noise impacts. Annexes 5 and 13 of the Technical Memorandum on Environmental Impact Assessment Process (EIAO-TM) set out the criteria and guidelines for evaluating noise impacts. Assessment procedures and standards are set out in the following technical memoranda and Guidance Note:

3.       Noise criteria

The Technical Memorandum on Environmental Impact Assessment Process (EIAO-TM) stipulates criteria of 65 - 75dB(A) for daytime construction activities, as shown in Table 3.1.

Table 3.1 Noise standards for daytime construction activities

Use

Noise Standards, Leq (30min) dB(A)

0700 - 1900 hours on any day not being a Sunday or general holiday

All domestic premises, Temporary housing accommodation, Hostels, Convalescent homes, and Homes for the aged

75

Places of public worship, Courts of law, and Hospitals and medical clinics

70

Educational institutions (including kindergartens and nurseries)

70

65 (During Examination)

Notes:

[1] The above standards apply to uses which rely on opened windows for ventilation and are assessed at 1m from the external façade.

[2] A Construction Noise Permit shall be required for carrying out relevant construction work during restricted hours under the Noise Control Ordinance. In case the applicant would like to evaluate whether carrying out relevant construction works during restricted hours under the Noise Control Ordinance is feasible or not in the context of programming construction works, reference should be made to relevant technical memoranda issued under the Noise Control Ordinance.

4.       Assessment Methodology

The assessment of noise impacts from the construction (excluding percussive piling) of the Project has been based on the methodology given in Annex 13 of the EIAO-TM. The typical approach is summarized as follows:

5.       Construction Programme

The Contractor has confirmed this scope of work, ensuring the noise assessment is focused and accurate. No construction activities other than specified below are permitted during this specific period.

The proposed construction works will be carried out only between 07:00 and 19:00 hours on any day not being a Sunday or general holiday. It is noted that Marine Department Notices (MDN) is required for permission of entering the site portion at sea area which will take usually 3-6 months for the issuance of MDN. Hence, the commencement of construction works at sea area will be subject to change and depend on the progress of obtaining MDN. The Contractor shall submit other CNMP reports for the any changes in construction period. As advised by the Contractor and broadly indicated in the construction programme in Appendix 5.1, the major construction works of the Project during Jan 2026 to May 2026 include:

6.       Identification of Noise Sensitive Receivers

The Project site is situated between Tung Chung town centre and Hong Kong Port (HKP) Island. The location of the Project is shown in Figure 6.1.

The noise sensitive receivers in the assessment area mainly comprise residential uses and the government, institution or community uses at Tung Chung town centre. The assessment area for noise impact generally include areas within 300m from the boundary of the Project and the works of the Project. Noise Sensitive Receivers (NSRs) within a distance of 300m from the boundary of the Project and the works of the Project have been identified. NSRs located within the first layer from the Project site and having openable windows for ventilation were selected as representative NSRs for assessment.

The identified existing, committed and planned NSRs, if any, within the assessment area are presented in Table 6.1 and their locations are shown in Figure 6.2.

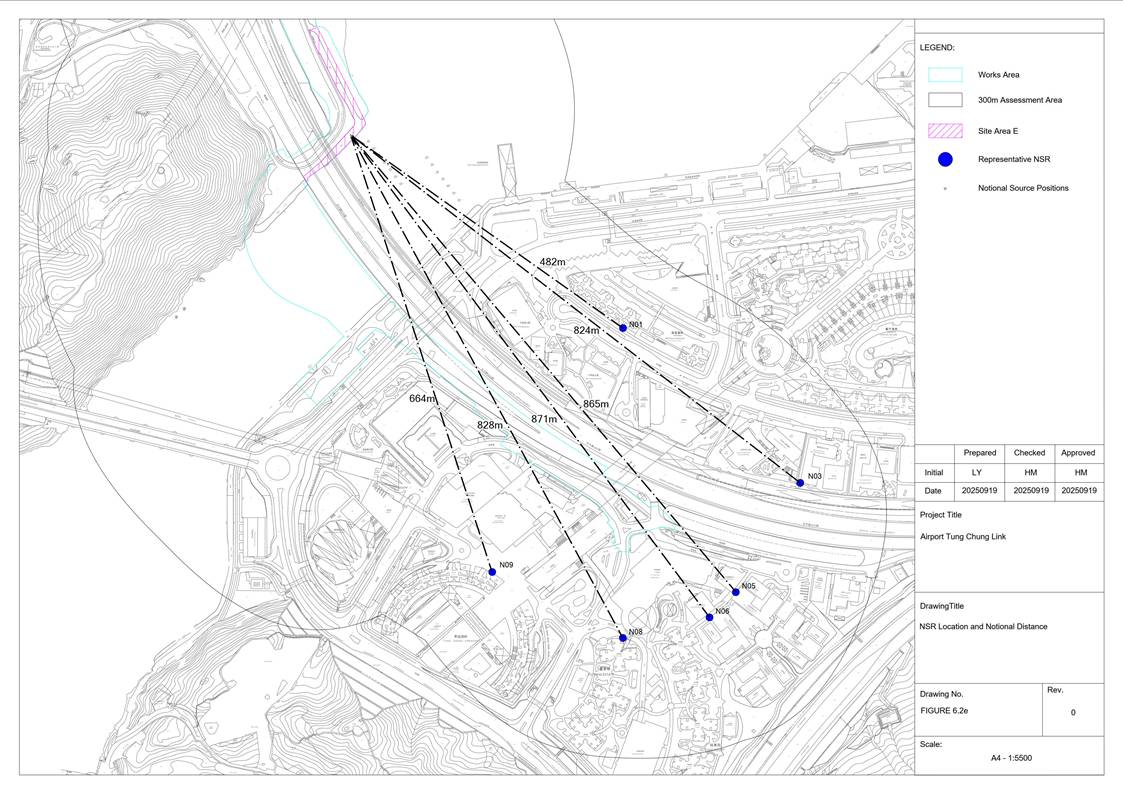

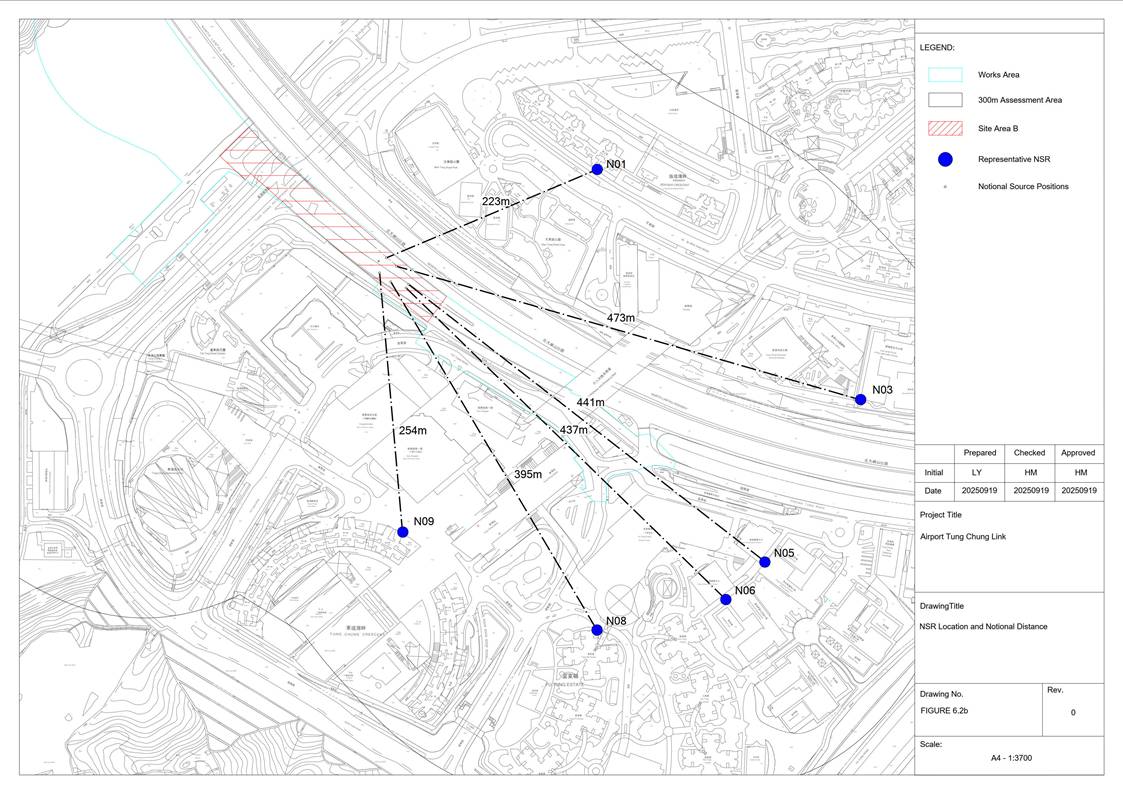

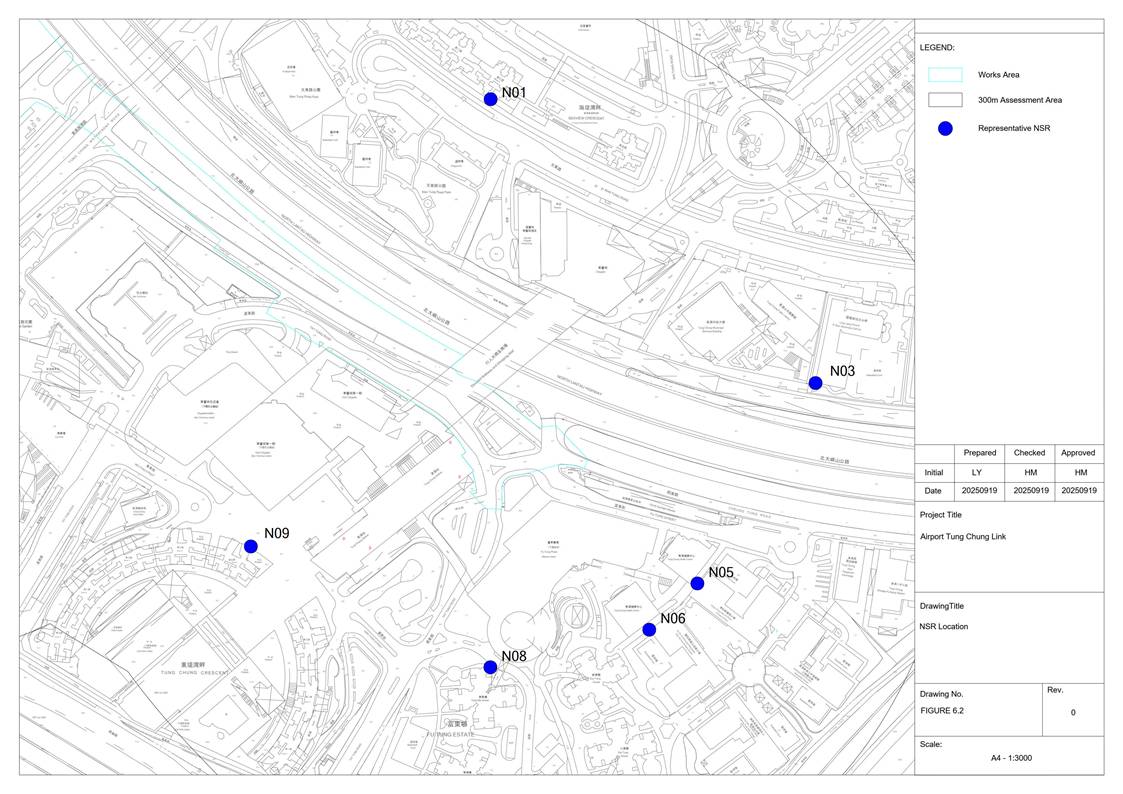

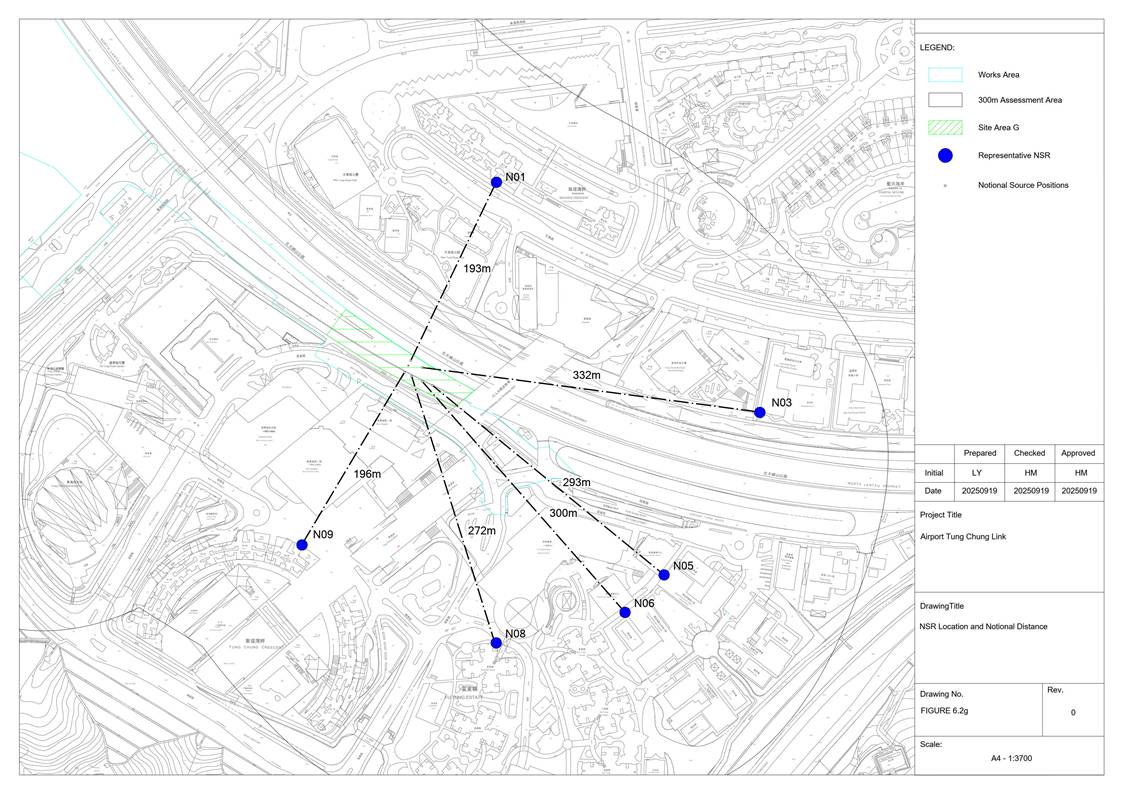

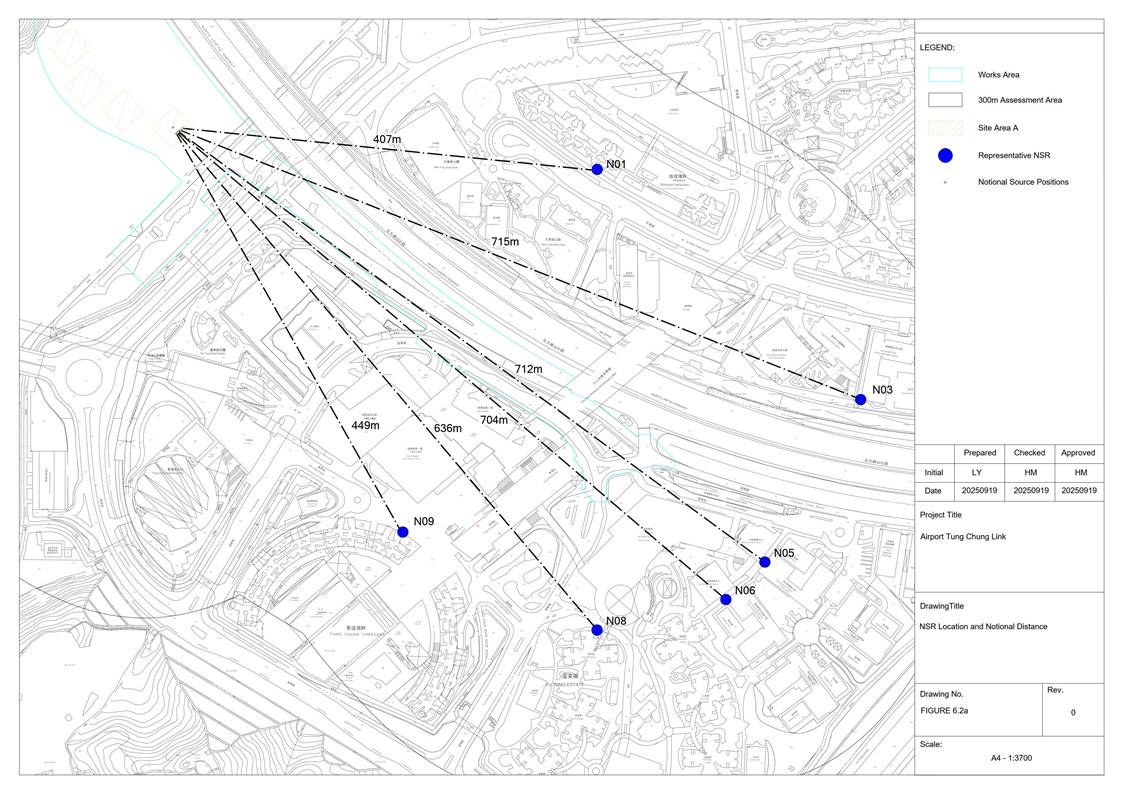

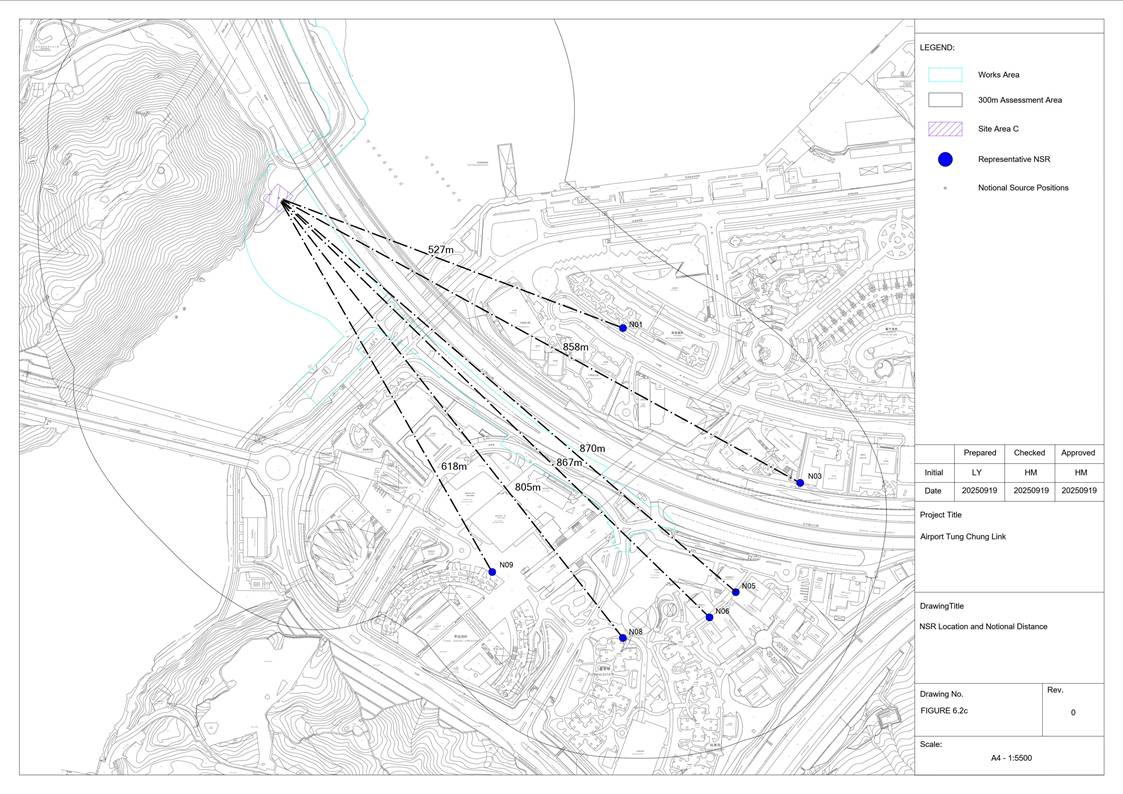

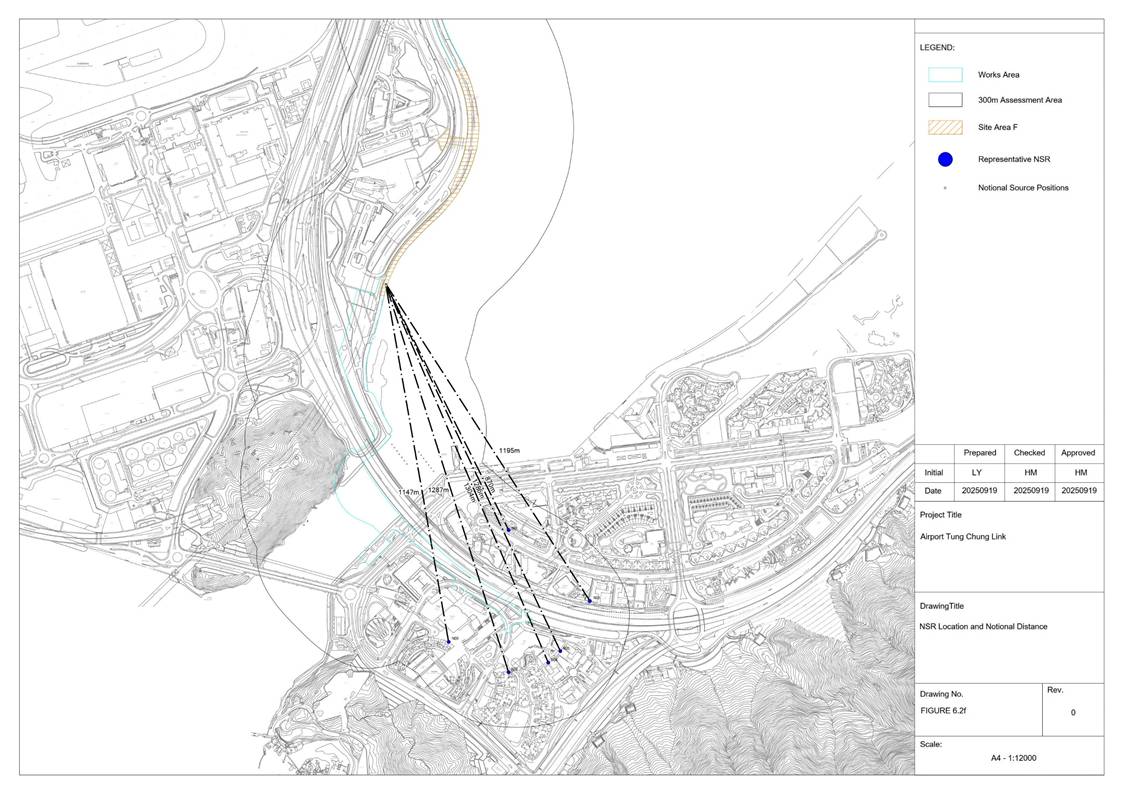

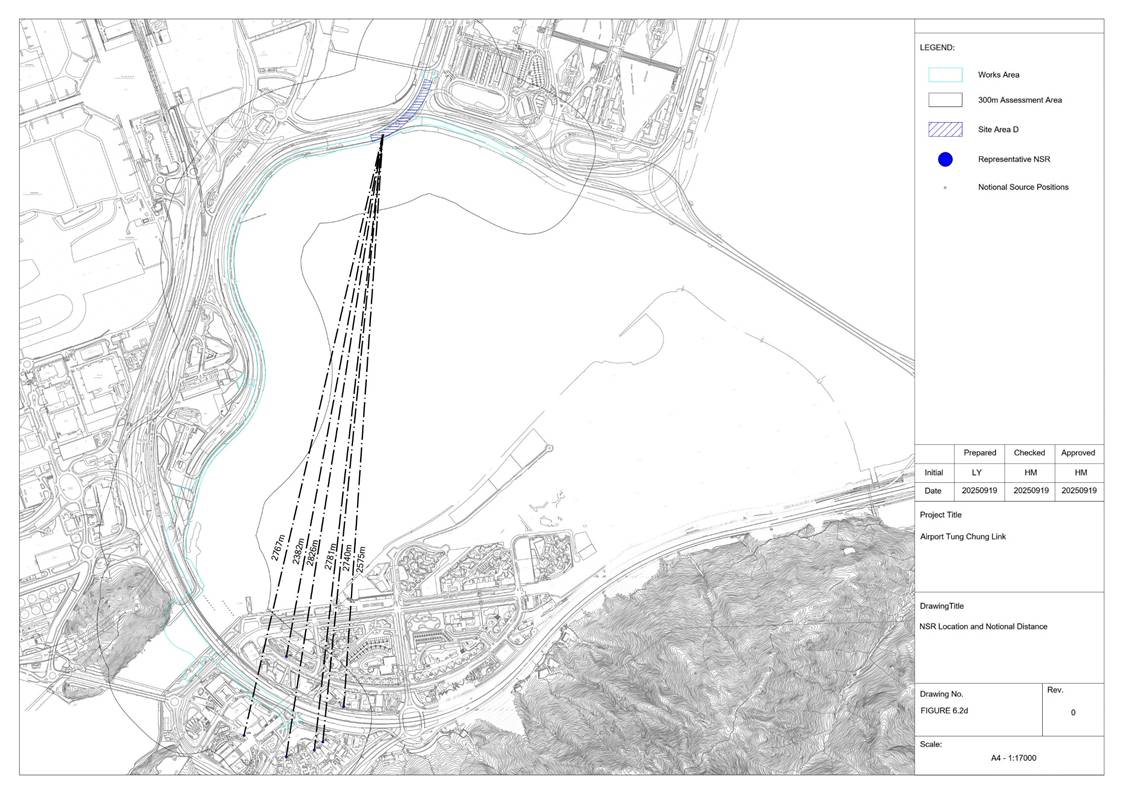

Table 6.1 Noise Sensitive Receivers (NSRs) Identified

NSR ID

Description

Uses

Existing/ Planned

N01

Seaview Crescent

Residential

Existing

N03

Ling Liang Church E Wun Secondary School

School

Existing

N05

Ching Chung Hau Po Woon Primary School

School

Existing

N06

Po On Commercial Association Wan Ho Kan Primary School

School

Existing

N08

Fu Tung Estate

Residential

Existing

N09

Tung Chung Crescent

Residential

Existing

N10 [3]

Priests’ Quarters of the Planned Visitation Church Development

Residential

Planned

Notes:

[1] The assessment will only include NSRs which rely on opened windows for ventilation.

[2] Only the first layer of NSRs has been selected for assessment.

[3] The tentative occupancy year of the planned NSR (N10) is 2028; therefore, it is not included in the assessment in this CNMP, and will be included in future CNMP as and when appropriate.

7.       Construction Noise Impact Assessment

Prediction and Evaluation of Construction Noise Impact (Unmitigated)

Potential source of noise impact arising from the construction of the Project would be the use of Powered Mechanical Equipment (PME) for various construction activities. The percentage on-time for each PME has been estimated individually for each construction activity to ensure practicality. The proposed construction plant inventory is recommended by the Contractor and provided in Appendix 7.2. The proposed construction plant inventory in Appendix 7.2 is considered technically feasible and confirmed by the Project engineer as workable, and would represent a realistic worst-case scenario for assessment purposes. The unmitigated construction noise impacts at the identified NSRs have been predicted accordingly. Details of unmitigated construction noise assessment are presented in Appendix 7.3 with the results summarized in Table 7.1.

For worst-case scenario, the noise mitigation criteria for schools were set to 65dB(A) for all months. As shown in Table 7.1, the construction noise levels at the identified representative construction NSRs would range from 69 to 77dB(A) for residential use and 68 to 70dB(A) for schools under the unmitigated scenario. The predicted construction noise levels would comply the relevant noise criteria except Tung Chung Crescent (N09) and schools during examination period (N03, N05, N06). Noise mitigation measures are therefore required to alleviate the construction noise impact on the affected NSRs.

Table 7.1 Predicted Construction Noise Levels under Unmitigated Scenario

NSR ID

Description

Uses

Predicted Construction Noise Level, Unmitigated, Leq (30mins), dB(A)

Noise Standards, dB(A)

Noise exceedance, dB(A)

N01

Seaview Crescent

Residential

74-75

75

0

N03

Ling Liang Church E Wun Secondary School

School

68-69

65

4

N05

Ching Chung Hau Po Woon Primary School

School

68-69

65

4

N06

Po On Commercial Association Wan Ho Kan Primary School

School

68-70

65

5

N08

Fu Tung Estate

Residential

69-70

75

0

N09

Tung Chung Crescent

Residential

75-77

75

2

Note:

[1] Cumulative noise level of other concurrent projects had been considered in the most affected NSR N09 Tung Chung Crescent.

Concurrent Project and Cumulative Impact

The Railway Development Strategy 2014 (RDS-2014) announced by the Government of the Hong Kong Special Administrative Region included the conceptual scheme of Tung Chung West (TCW) Extension and a possible Tung Chung East (TCE) Station. The works areas and construction programme of Tung Chung Line Extension have been reviewed based on latest available information. The location of the concurrent project is shown in Figure 6.1. According to Construction Noise Management Plan (Nov 2024) for Works Contract 1201, their latest works areas and works sites are within of 300m of the one of the NSRs (Tung Chung Crescent) of this Project (Appendix 7.7 refers). It is noted that the representative NSR at Tung Chung Crescent in this CNMP is facing away from the construction site of Tung Chung Line Extension, a conservative construction noise level from the construction site of Tung Chung Line Extension at Tung Chung Crescent in Construction Noise Management Plan (Nov 2024) for Works Contract 1201 had been adopted in cumulative assessment for conservative approach. The cumulative construction noise impact from construction of Tung Chung Line Extension is presented in calculation Appendix 7.3.

It is noted that the sewage upgrade work of three runway system (3RS) would be constructed near TCCS and commenced no earlier than 2027, the relevant information of the sewage upgrading work of 3RS EIA report will be included in the future CNMP as and when available.

Use of Quieter PME and Quality Powered Mechanical Equipment (QPME)

Taking into account the latest construction programme and PME inventory provided by the Contractor, quieter PME for mobile crane, air compressor and generator are proposed as listed in Table 7.2. However, if the exact model specified in the references/QPME labels of the listed quieter PME are not available, or the QPME label has expired during the construction period, the model with SWL not higher than the listed SWL shall be adopted.

Table 7.2 Quality PME Proposed for Adoption during Construction Phase

PME

Reference

SWL, dB(A)

Crane, mobile

QPME: EPD-10143

100

Air Compressor

QPME: EPD-11726

100

Generator

QPME: EPD-12349

90

Note:

[1] The SWL is prescribed in Quality Powered Mechanical Equipment (QPME) in EPD website.

Quieter Construction Methods

The below quieter construction methods have been considered and assumed to be applied in all construction works areas in the EIA Report (AEIAR-254/2023). As advised by the Contractor, the methods shall be applied construction works whenever applicable.

Use of Noise Barrier, Noise Enclosure and Noise Insulating Fabric

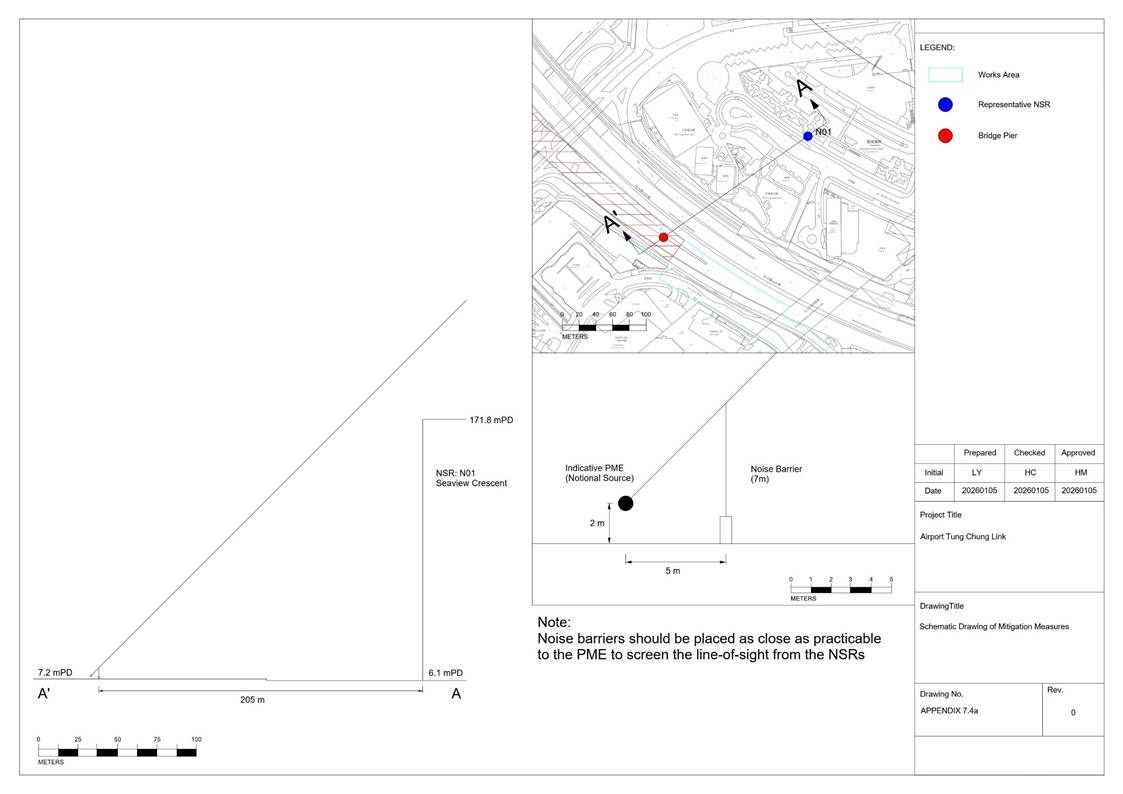

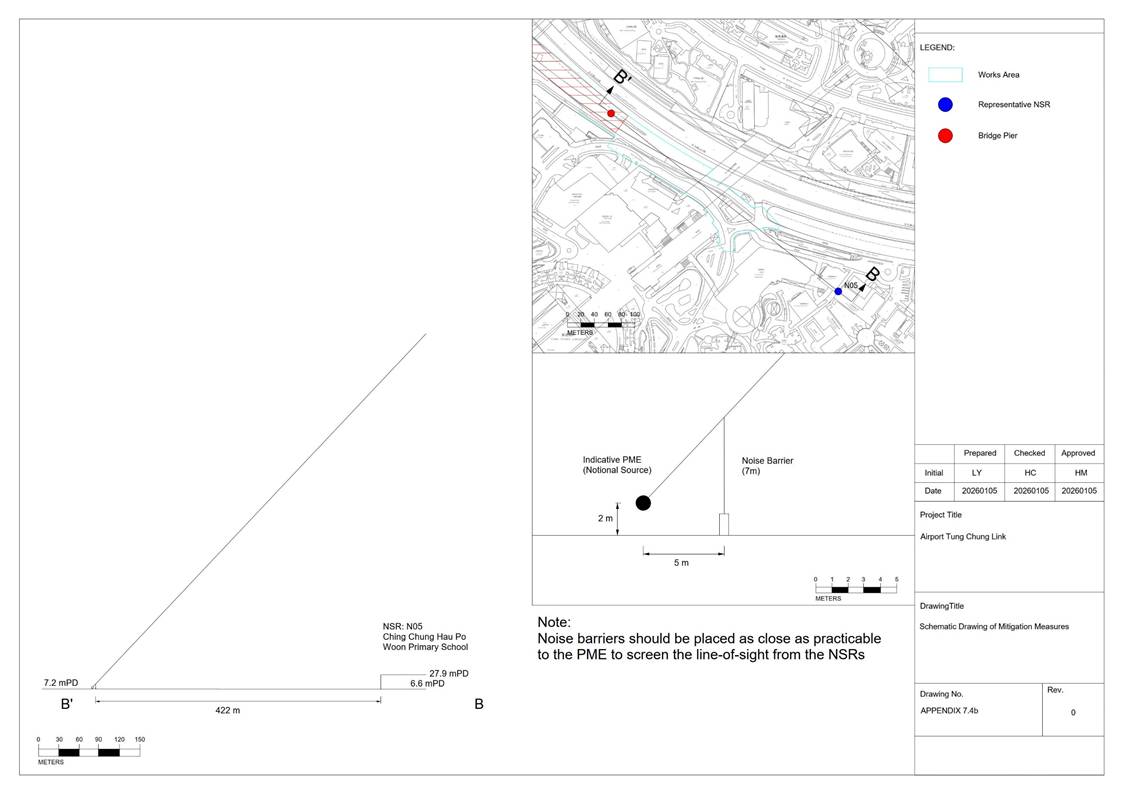

Proprietary noise barriers will be used for screening noise to NSRs and could achieve an insertion loss of 22 dB(A). The height of the proprietary noise barriers can be up to 7m can applied as close to the PME, this proprietary noise barriers will be capable to shield the PME from the NSR completely. The catalogue and schematic drawing of noise barrier is shown in Appendix 7.4. The noise barrier will be placed as close to the PME as possible and a location intercepting the line of sight between NSRs and PME. Gaps and openings at joints in the barrier material should be avoided. The barrier should also be long enough to minimize the degradation caused by the diffraction along the short edges. With reference to EIAO Guidance Note No.9/2023, noise reduction of 5dB(A) and 10dB(A) can be achieved by noise barriers for movable and stationary plant respectively. Following the assumptions in the Approved ATCL EIA Report, it is anticipated that suitably designed movable barriers/acoustic sheet barriers could achieve at least 5 to 10 dB(A) reduction. For a conservative assessment, only a reduction of 5 dB(A) is assumed.

Other noise mitigations such as noise enclosure and noise insulating fabric shall be considered if necessary.

Use of Soundproof Hammer Bracket for Hydraulic Breaker

Soundproof hammer bracket will be installed to reduce the noise from hydraulic breaker. According to the Best Practice Guide for Environmental Protection on Construction Sites, hammer bracket can achieve 10dB(A) noise reduction. The mitigation will include tuned mass dampers installed on the breaker head; tailored breaker cloth wrapped around the breaker head (minimum 7kg/m2 surface density); and noise mitigating plastic skirt wrapped around the chisel tip of the breaker.

Prediction and Evaluation of Construction Noise Impact (Mitigated)

The implementation schedule of proposed mitigation measures is showed in Appendix 7.6. With the implementation of noise mitigations, the predicted construction noise levels at representative construction NSRs have been predicted and presented in Appendix 7.5 with the results summarized in Table 7.3. The relevant construction plant inventory could be referred to Appendix 7.2.

Table 7.3 Predicted Construction Noise Levels under Mitigated Scenario

NSR ID

Description

Uses

Predicted Construction Noise Level, Mitigated,
Leq (30mins), dB(A)

Noise Standards, dB(A)

Noise exceedance, dB(A)

N01

Seaview Crescent

Residential

68-70

75

0

N03

Ling Liang Church E Wun Secondary School

School

62-64

65

0

N05

Ching Chung Hau Po Woon Primary School

School

63-65

65

0

N06

Po On Commercial Association Wan Ho Kan Primary School

School

63-65

65

0

N08

Fu Tung Estate

Residential

64-66

75

0

N09

Tung Chung Crescent

Residential

73-75

75

0

With the implementation of proposed noise mitigations, the predicted construction noise level would comply with the relevant noise criteria, adverse construction noise impact would not be anticipated.

8.       Good Site Practices

In addition to the mitigation measures listed above, there are also some good site practices that can further reduce the noise levels at NSRs. However, they are non-quantifiable and thus not included in the assessment. These include:

9.       CONCLUSION

This CNMP has identified the noise source inventory and assess the necessity of construction noise mitigation measures, including the use of quality powered mechanical equipment, noise barriers and noise enclosures for works at ATCL project. With the implementation of the proposed noise mitigations and recommended good practices, noise impacts during construction phases are expected to achieve full compliance of relevant noise criteria.

This CNMP focused on the construction works conducted during Jan 2026 to May 2026 only and the remaining construction period is subject to change. The Contractor will submit other CNMP reports for the remaining construction period once the details become available. If there is any update on the construction works conducted from Jan 2026 to May 2026, a revised CNMP will be submitted to the EPD.

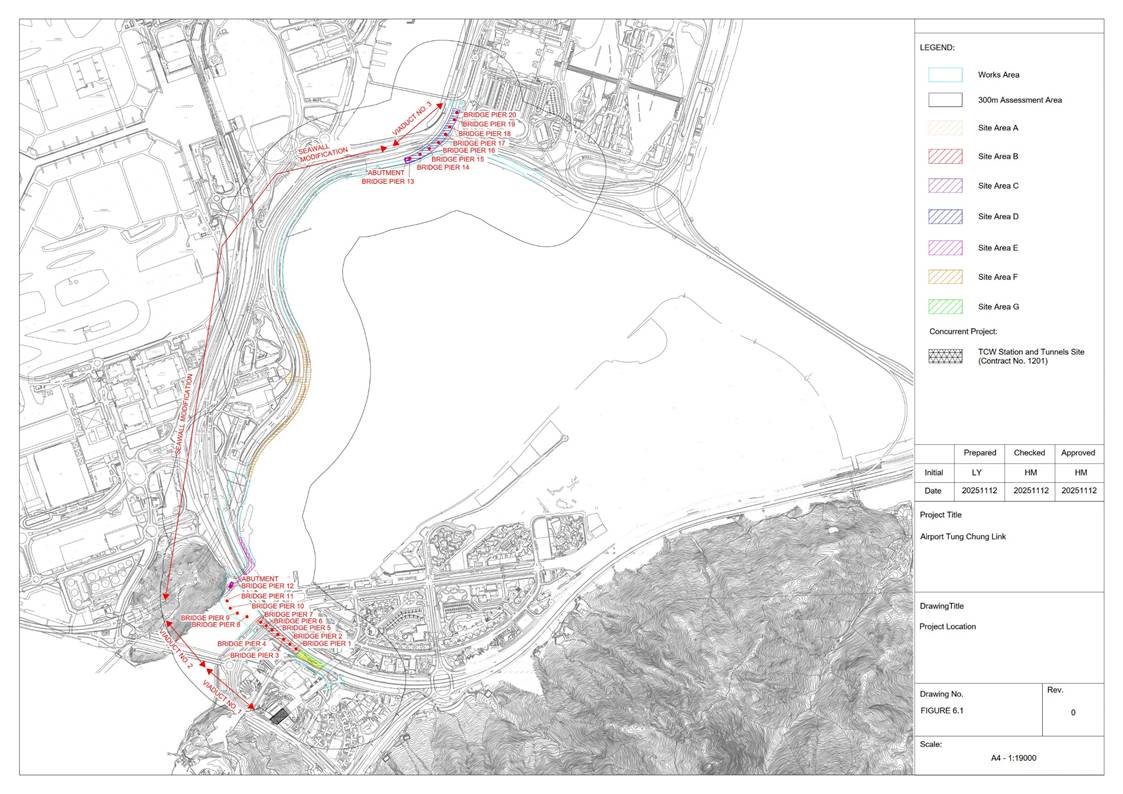

Figure 6.1:
Project Location

Figure 6.2:
NSR Location

Appendix 5.1:
CONSTRUCTION Programme

Appendix 7.2:
proposed construction plant inventory

Airport Tung Chung Link

ID

PME

TM or other ref.

No. of PME

SWL dB(A)/unit

% on time

Total SWL dB(A)

Noise Mitigation Measure

SWL dB(A)/unit

Screening Effect dB(A)

Total SWL dB(A)

Group

Description

Construction Works of Bored Pile (Pier 1-7)

Before Mitigation

After Mitigation

P1

P1A

Crane, mobile

CNP 048

3

112

50%

114

QPME

100

0

102

Piling, large diameter bored, oscillator

CNP 165

2

115

70%

116

Noise Barrier

115

-5

111

Lorry, with crane/grab, gross vehicle weight > 38 tonne

OCUCNP

2

112

50%

112

Noise Barrier

112

-5

107

Piling, large diameter bored, reverse circulation drill

CNP 166

2

100

70%

101

100

0

101

Air compressor, air flow > 10 m³/min and ≤ 30 m³/min

CNP 002

2

102

70%

103

QPME, Noise Barrier

100

-5

96

Generator, super silenced, 70 dB(A) at 7 m

CNP 103

2

95

70%

96

QPME

90

0

91

Power pack (diesel)

OCUCNP

2

100

70%

101

Noise Barrier

100

-5

96

Bar bender and cutter (electric)

CNP 021

2

90

50%

90

90

0

90

Water pump (electric)

CNP 281

6

88

50%

93

88

0

93

Concrete lorry mixer

CNP 044

2

109

100%

112

Noise Barrier

109

-5

107

Concrete pump, stationary/lorry mounted

CNP 047

2

109

100%

112

Noise Barrier

109

-5

107

Dump Truck, 5.5 tonne < gross vehicle weight ≤ 38 tonne

OCUCNP

2

105

50%

105

105

0

105

Breaker, electric hand-held, 18kg ≤ mass ≤ 35kg

OCUCNP

2

108

100%

111

Noise Barrier

108

-5

106

Drill, hand-held (battery)

OCUCNP

2

89

50%

89

Noise Barrier

89

-5

84

Welding machine

OCUCNP

3

80

100%

85

80

0

85

Wastewater treatment plant, water flow rate ≤ 80m3/hr

OCUCNP

2

83

100%

86

83

0

86

Lorry, gross vehicle weight > 38 tonne

OCUCNP

2

112

50%

112

112

0

112

Excavator, wheeled/tracked

CNP 081

2

112

100%

115

Noise Barrier

112

-5

110

Breaker, excavator mounted (hydraulic)

CNP 028

1

122

70%

120

Hammer Bracket

122

-10

110

Quieter Type Saw [5]

106

0

104

Total

125

Total

119

P1B

Crane, mobile

CNP 048

3

112

50%

114

QPME

100

0

102

Piling, vibrating hammer

OCUCNP

2

115

70%

116

Noise Barrier

115

-5

111

Lorry, with crane/grab, gross vehicle weight > 38 tonne

OCUCNP

2

112

50%

112

Noise Barrier

112

-5

107

Piling, large diameter bored, reverse circulation drill

CNP 166

2

100

70%

101

100

0

101

Air compressor, air flow > 10 m³/min and ≤ 30 m³/min

CNP 002

2

102

70%

103

QPME, Noise Barrier

100

-5

96

Generator, super silenced, 70 dB(A) at 7 m

CNP 103

2

95

70%

96

QPME

90

0

91

Power pack (diesel)

OCUCNP

2

100

70%

101

Noise Barrier

100

-5

96

Bar bender and cutter (electric)

CNP 021

2

90

50%

90

90

0

90

Water pump (electric)

CNP 281

6

88

50%

93

88

0

93

Concrete lorry mixer

CNP 044

2

109

100%

112

Noise Barrier

109

-5

107

Concrete pump, stationary/lorry mounted

CNP 047

2

109

100%

112

Noise Barrier

109

-5

107

Dump Truck, 5.5 tonne < gross vehicle weight ≤ 38 tonne

OCUCNP

2

105

50%

105

105

0

105

Breaker, electric hand-held, 18kg ≤ mass ≤ 35kg

OCUCNP

2

108

100%

111

Noise Barrier

108

-5

106

Drill, hand-held (battery)

OCUCNP

2

89

50%

89

Noise Barrier

89

-5

84

Welding machine

OCUCNP

3

80

100%

85

80

0

85

Wastewater treatment plant, water flow rate ≤ 80m3/hr

OCUCNP

2

83

100%

86

83

0

86

Lorry, gross vehicle weight > 38 tonne

OCUCNP

2

112

50%

112

112

0

112

Excavator, wheeled/tracked

CNP 081

2

112

100%

115

Noise Barrier

112

-5

110

Breaker, excavator mounted (hydraulic)

CNP 028

1

122

70%

120

Hammer Bracket

122

-10

110

Quieter Type Saw [5]

106

0

104

Total

125

Total

119

Max SWL

125

Max SWL

119

Construction Works of Bored Pile (Pier 13-20)

P4

P4A

Crane, mobile

CNP 048

3

112

50%

114

QPME

100

0

102

Piling, large diameter bored, oscillator

CNP 165

2

115

70%

116

115

0

116

Lorry, with crane/grab, gross vehicle weight > 38 tonne

OCUCNP

2

112

50%

112

112

0

112

Piling, large diameter bored, reverse circulation drill

CNP 166

2

100

70%

101

100

0

101

Air compressor, air flow > 10 m³/min and ≤ 30 m³/min

CNP 002

2

102

70%

103

QPME

100

0

101

Generator, super silenced, 70 dB(A) at 7 m

CNP 103

2

95

70%

96

QPME

90

0

91

Power pack (diesel)

OCUCNP

2

100

70%

101

100

0

101

Bar bender and cutter (electric)

CNP 021

2

90

50%

90

90

0

90

Water pump (electric)

CNP 281

6

88

50%

93

88

0

93

Concrete lorry mixer

CNP 044

2

109

100%

112

109

0

112

Concrete pump, stationary/lorry mounted

CNP 047

2

109

100%

112

109

0

112

Dump Truck, 5.5 tonne < gross vehicle weight ≤ 38 tonne

OCUCNP

2

105

50%

105

105

0

105

Breaker, electric hand-held, 18kg ≤ mass ≤ 35kg

OCUCNP

2

108

100%

111

108

0

111

Drill, hand-held (battery)

OCUCNP

2

89

50%

89

89

0

89

Welding machine

OCUCNP

3

80

100%

85

80

0

85

Wastewater treatment plant, water flow rate ≤ 80m3/hr

OCUCNP

2

83

100%

86

83

0

86

Lorry, gross vehicle weight > 38 tonne

OCUCNP

2

112

50%

112

112

0

112

Excavator, wheeled/tracked

CNP 081

2

112

100%

115

112

0

115

Breaker, excavator mounted (hydraulic)

CNP 028

1

122

70%

120

122

0

120

Quieter Type Saw [5]

106

0

104

Total

125

Total

124

P4B

Crane, mobile

CNP 048

3

112

50%

114

QPME

100

0

102

Piling, vibrating hammer

OCUCNP

2

115

70%

116

115

0

116

Lorry, with crane/grab, gross vehicle weight > 38 tonne

OCUCNP

2

112

50%

112

112

0

112

Piling, large diameter bored, reverse circulation drill

CNP 166

2

100

70%

101

100

0

101

Air compressor, air flow > 10 m³/min and ≤ 30 m³/min

CNP 002

2

102

70%

103

QPME

100

0

101

Generator, super silenced, 70 dB(A) at 7 m

CNP 103

2

95

70%

96

QPME

90

0

91

Power pack (diesel)

OCUCNP

2

100

70%

101

100

0

101

Bar bender and cutter (electric)

CNP 021

2

90

50%

90

90

0

90

Water pump (electric)

CNP 281

6

88

50%

93

88

0

93

Concrete lorry mixer

CNP 044

2

109

100%

112

109

0

112

Concrete pump, stationary/lorry mounted

CNP 047

2

109

100%

112

109

0

112

Dump Truck, 5.5 tonne < gross vehicle weight ≤ 38 tonne

OCUCNP

2

105

50%

105

105

0

105

Breaker, electric hand-held, 18kg ≤ mass ≤ 35kg

OCUCNP

2

108

100%

111

108

0

111

Drill, hand-held (battery)

OCUCNP

2

89

50%

89

89

0

89

Welding machine

OCUCNP

3

80

100%

85

80

0

85

Wastewater treatment plant, water flow rate ≤ 80m3/hr

OCUCNP

2

83

100%

86

83

0

86

Lorry, gross vehicle weight > 38 tonne

OCUCNP

2

112

50%

112

112

0

112

Excavator, wheeled/tracked

CNP 081

2

112

100%

115

112

0

115

Breaker, excavator mounted (hydraulic)

CNP 028

1

122

70%

120

122

0

120

Quieter Type Saw [5]

106

0

104

Total

125

Total

124

Max SWL

125

Max SWL

124

Construction Works of Bored Pile (Pier 12)

P2

P2A

Crane, mobile

CNP 048

1

112

50%

109

QPME

100

0

97

Piling, large diameter bored, oscillator

CNP 165

1

115

70%

113

Noise Barrier

115

-5

108

Piling, vibrating hammer

OCUCNP

1

115

70%

113

Noise Barrier

115

-5

108

Lorry, with crane/grab, gross vehicle weight > 38 tonne

OCUCNP

1

112

50%

109

Noise Barrier

112

-5

104

Piling, large diameter bored, reverse circulation drill

CNP 166

1

100

70%

98

100

0

98

Air compressor, air flow > 10 m³/min and ≤ 30 m³/min

CNP 002

1

102

70%

100

QPME, Noise Barrier

100

-5

93

Generator, super silenced, 70 dB(A) at 7 m

CNP 103

1

95

70%

93

QPME

90

0

88

Power pack (diesel)

OCUCNP

2

100

70%

101

Noise Barrier

100

-5

96

Bar bender and cutter (electric)

CNP 021

1

90

50%

87

90

0

87

Water pump (electric)

CNP 281

3

88

50%

90

88

0

90

Concrete lorry mixer

CNP 044

1

109

100%

109

Noise Barrier

109

-5

104

Concrete pump, stationary/lorry mounted

CNP 047

1

109

100%

109

Noise Barrier

109

-5

104

Dump Truck, 5.5 tonne < gross vehicle weight ≤ 38 tonne

OCUCNP

1

105

50%

102

105

0

102

Breaker, electric hand-held, 18kg ≤ mass ≤ 35kg

OCUCNP

1

108

100%

108

Noise Barrier

108

-5

103

Wastewater treatment plant, water flow rate ≤ 80m3/hr

OCUCNP

1

83

100%

83

83

0

83

Excavator, wheeled/tracked

CNP 081

2

112

100%

115

Noise Barrier

112

-5

110

Breaker, excavator mounted (hydraulic)

CNP 028

2

122

70%

123

Hammer Bracket

122

-10

113

Quieter Type Saw [5]

106

0

107

Total

125

Total

118

Construction Works of Marine Viaduct (Pier 8-11)

P3

P3A

Crane, barge mounted (diesel)

CNP 048

1

112

70%

110

112

0

110

Piling, large diameter bored, reverse circulation drill

CNP 166

1

100

70%

98

100

0

98

Air compressor, air flow > 10 m³/min and ≤ 30 m³/min

CNP 002

1

102

70%

100

QPME

100

0

98

Power pack (diesel)

OCUCNP

1

100

70%

98

100

0

98

Derrick barge

CNP 061

1

104

70%

102

104

0

102

Tug boat

CNP 221

3

110

70%

113

110

0

113

Dump Truck, 5.5 tonne < gross vehicle weight ≤ 38 tonne

OCUCNP

2

105

50%

105

105

0

105

Concrete lorry mixer

CNP 044

4

109

100%

115

109

0

115

Concrete pump, stationary/lorry mounted

CNP 047

2

109

100%

112

109

0

112

Welding machine

OCUCNP

1

80

100%

80

80

0

80

Lorry, with crane/grab, gross vehicle weight > 38 tonne

OCUCNP

2

112

50%

112

112

0

112

Total

120

Total

120

P3B

Crane, mobile

CNP 048

1

112

50%

109

QPME

100

0

97

Lorry, with crane/grab, gross vehicle weight > 38 tonne

OCUCNP

1

112

50%

109

112

0

109

Drill rig, rotary type (diesel)

OCUCNP

1

110

70%

108

110

0

108

Air compressor, air flow > 10 m³/min and ≤ 30 m³/min

CNP 002

1

102

70%

100

QPME

100

0

98

Generator, super silenced, 70 dB(A) at 7 m

CNP 103

1

95

70%

93

QPME

90

0

88

Welding machine

OCUCNP

3

80

100%

85

80

0

85

Water pump (electric)

CNP 281

3

88

50%

90

88

0

90

Excavator, wheeled/tracked

CNP 081

2

112

100%

115

112

0

115

Total

117

Total

117

P3C

Crane, mobile

CNP 048

1

112

50%

109

QPME

100

0

97

Piling, vibrating hammer

OCUCNP

1

115

70%

113

115

0

113

Total

115

Total

114

Max SWL

120

Max SWL

120

Construction Works of Sea Wall Modification

S1

S1A

Crane, mobile

CNP 048

2

112

50%

112

QPME

100

0

100

Excavator, wheeled/tracked

CNP 081

3

112

70%

115

112

0

115

Dump Truck, 5.5 tonne < gross vehicle weight ≤ 38 tonne

OCUCNP

3

105

50%

107

105

0

107

Lorry, with crane/grab, gross vehicle weight > 38 tonne

OCUCNP

3

112

50%

114

112

0

114

Generator, super silenced, 70 dB(A) at 7 m

CNP 103

2

95

70%

96

QPME

90

0

91

Wastewater treatment plant, water flow rate ≤ 80m3/hr

OCUCNP

1

83

100%

83

83

0

83

Water pump (electric)

CNP 281

10

88

50%

95

88

0

95

Total

119

Total

118

Construction Works of Tung Chung Central Station (Sheet Pile)

T1

T1A

Crane, mobile

CNP 048

1

112

50%

109

QPME

100

0

97

Excavator, wheeled/tracked

CNP 081

1

112

70%

110

112

0

110

Piling, vibrating hammer

OCUCNP

1

115

70%

113

Press-in piling [6]

94

0

92

Lorry, with crane/grab, gross vehicle weight > 38 tonne

OCUCNP

1

112

50%

109

112

0

109

Generator, super silenced, 70 dB(A) at 7 m

CNP 103

2

95

70%

96

QPME

90

0

91

Water pump (electric)

CNP 281

3

88

50%

90

88

0

90

Grinder, hand-held (electric)

CNP 065

1

98

100%

98

98

0

98

Wastewater treatment plant, water flow rate ≤ 80m3/hr

OCUCNP

1

83

100%

83

83

0

83

Welding machine

OCUCNP

1

80

100%

80

80

0

80

Total

117

Total

113

[1] The plant list and percentage on time are advised by the Contractor

[2] The SWLs are referred to the following references

CNP - Table 3 - Sound Power Levels for Items of Powered Mechanical Equipment (PME) of Technical Memorandum on Noise from Construction Work Other Than Percussive Piling (GW-TM) issued

OCUCNP - Sound power levels of other commonly used PME obtained from https://www.epd.gov.hk/epd/sites/default/files/epd/english/application_for_licences/guidance/files/OtherSWLs_eng.pdf

EPD - EPD Website https://www.epd.gov.hk/epd/misc/construction_noise/contents/index.php/en/home2/quieter-construction-methods/item/133-quieter-type-wire-saw.html

[3]: According to EIAO Guidance Note No. 9/2023, with provision of noise barriers, a 5dB(A) noise reduction for movable plant, 10 dB(A) for stationary plant and 15 dB(A) for enclosed ones can be assumed (depending on the actual design). Schematic Drawings of the proposed mitigation measures are presented at Appendix 7.4

[4]: PMEs in each sub-group would not take place with others at the same time

[5]: The SWL of Quieter Type Saw is converted from SPL by distance attenuation in point source, and the SPL at 7m from the equipment is referenced to EPD website: https://www.epd.gov.hk/epd/misc/construction_noise/contents/index.php/en/home2/quieter-construction-methods/item/133-quieter-type-wire-saw.html

[6]: The SWL of Press-in-piling is converted from SPL by distance attenuation in point source, and the SPL at 7m from the equipment is referenced to EPD website: https://www.epd.gov.hk/epd/misc/construction_noise/contents/index.php/en/home2/quieter-construction-equipment/item/27-press-in-method.html

Appendix 7.3:
Construction noise calculations (Unmitigated)

Airport Tung Chung Link

Predicted Construction Noise Levels for Representative NSRs

Unmitigated Scenario

NSR:

N01 Seaview Crescent

Site Area

Activities

ID

SWL

Dist.

Façade Corr.

SPL

Year

2025

2026

Month

10

11

12

1

2

3

4

5

Project Month

3

4

5

6

7

8

9

10

A

Viaduct 2 (Pier 8 - Pier 11)

P3

120

407

3

63

63

63

63

B

Viaduct 1 (Pier 1 - Pier 7)

P1

125

223

3

73

73

73

73

73

73

C

Viaduct 2 (Pier 12)

P2

125

527

3

66

66

66

66

D

Viaduct 3 (Pier 13 - Pier 20)

P4

125

2382

3

52

52

52

52

52

E

Sea Wall Modification

S1

119

482

3

60

60

60

F

Sea Wall Modification

S1

119

870

3

55

55

55

G

Tung Chung Central Station (Sheet Pile)

T1

117

193

3

66

66

66

66

Total SPL, dB(A)

74

74

75

74

74

Noise criteria, dB(A)

75

75

75

75

75

NSR:

N03 Ling Liang Church E Wun Secondary School

Site Area

Activities

ID

SWL

Dist.

Façade Corr.

SPL

Year

2025

2026

Month

10

11

12

1

2

3

4

5

Project Month

3

4

5

6

7

8

9

10

A

Viaduct 2 (Pier 8 - Pier 11)

P3

120

715

3

58

58

58

58

B

Viaduct 1 (Pier 1 - Pier 7)

P1

125

473

3

66

66

66

66

66

66

C

Viaduct 2 (Pier 12)

P2

125

858

3

62

62

62

62

D

Viaduct 3 (Pier 13 - Pier 20)

P4

125

2575

3

52

52

52

52

52

E

Sea Wall Modification

S1

119

824

3

56

56

56

F

Sea Wall Modification

S1

119

1195

3

52

52

52

G

Tung Chung Central Station (Sheet Pile)

T1

117

332

3

62

62

62

62

Total SPL, dB(A)

68

68

69

68

68

Noise criteria, dB(A)

65

65

65

65

65

NSR:

N05 Ching Chung Hau Po Woon Primary School

Site Area

Activities

ID

SWL

Dist.

Façade Corr.

SPL

Year

2025

2026

Month

10

11

12

1

2

3

4

5

Project Month

3

4

5

6

7

8

9

10

A

Viaduct 2 (Pier 8 - Pier 11)

P3

120

712

3

58

58

58

58

B

Viaduct 1 (Pier 1 - Pier 7)

P1

125

441

3

67

67

67

67

67

67

C

Viaduct 2 (Pier 12)

P2

125

870

3

62

62

62

62

D

Viaduct 3 (Pier 13 - Pier 20)

P4

125

2740

3

51

51

51

51

51

E

Sea Wall Modification

S1

119

865

3

55

55

55

F

Sea Wall Modification

S1

119

1286

3

52

52

52

G

Tung Chung Central Station (Sheet Pile)

T1

117

293

3

63

63

63

63

Total SPL, dB(A)

68

68

69

69

69

Noise criteria, dB(A)

65

65

65

65

65

[1] SPL = SWL - 10*log(2*PI*r2 ) + façade correction [where PI = 3.1416 and r is the distance of NSR from notional noise source]

[2] The figures are rounded-off to a whole number

[3] Construction work for Pier 8-11 will not overlap with each other

[4] Max SWL is adopted for activity ID P1, P3 and P4 in the calculation for worst-case scenario

Airport Tung Chung Link

Predicted Construction Noise Levels for Representative NSRs

Unmitigated Scenario

NSR:

N06 Po On Commercial Association Wan Ho Kan Primary School

Site Area

Activities

ID

SWL

Dist.

Façade Corr.

SPL

Year

2025

2026

Month

10

11

12

1

2

3

4

5

Project Month

3

4

5

6

7

8

9

10

A

Viaduct 2 (Pier 8 - Pier 11)

P3

120

704

3

58

58

58

58

B

Viaduct 1 (Pier 1 - Pier 7)

P1

125

437

3

67

67

67

67

67

67

C

Viaduct 2 (Pier 12)

P2

125

867

3

62

62

62

62

D

Viaduct 3 (Pier 13 - Pier 20)

P4

125

2781

3

51

51

51

51

51

E

Sea Wall Modification

S1

119

871

3

55

55

55

F

Sea Wall Modification

S1

119

1304

3

52

52

52

G

Tung Chung Central Station (Sheet Pile)

T1

117

300

3

62

62

62

62

Total SPL, dB(A)

68

68

70

69

69

Noise criteria, dB(A)

65

65

65

65

65

NSR:

N08 Fu Tung Estate

Site Area

Activities

ID

SWL

Dist.

Façade Corr.

SPL

Year

2025

2026

Month

10

11

12

1

2

3

4

5

Project Month

3

4

5

6

7

8

9

10

A

Viaduct 2 (Pier 8 - Pier 11)

P3

120

636

3

59

59

59

59

B

Viaduct 1 (Pier 1 - Pier 7)

P1

125

395

3

68

68

68

68

68

68

C

Viaduct 2 (Pier 12)

P2

125

805

3

62

62

62

62

D

Viaduct 3 (Pier 13 - Pier 20)

P4

125

2826

3

51

51

51

51

51

E

Sea Wall Modification

S1

119

828

3

56

56

56

F

Sea Wall Modification

S1

119

1287

3

52

52

52

G

Tung Chung Central Station (Sheet Pile)

T1

117

272

3

63

63

63

63

Total SPL, dB(A)

69

69

70

70

70

Noise criteria, dB(A)

75

75

75

75

75

NSR:

N09 Tung Chung Crescent

Site Area

Activities

ID

SWL

Dist.

Façade Corr.

SPL

Year

2025

2026

Month

10

11

12

1

2

3

4

5

Project Month

3

4

5

6

7

8

9

10

A

Viaduct 2 (Pier 8 - Pier 11)

P3

120

449

3

62

62

62

62

B

Viaduct 1 (Pier 1 - Pier 7)

P1

125

254

3

72

72

72

72

72

72

C

Viaduct 2 (Pier 12)

P2

125

618

3

65

65

65

65

D

Viaduct 3 (Pier 13 - Pier 20)

P4

125

2767

3

51

51

51

51

51

E

Sea Wall Modification

S1

119

664

3

58

58

58

F

Sea Wall Modification

S1

119

1147

3

53

53

53

G

Tung Chung Central Station (Sheet Pile)

T1

117

196

3

66

66

66

66

Total SPL, dB(A)

73

73

74

73

73

SPL from TCW Station and Tunnels (1201), dB(A)

72

74

74

74

71

Cumulative SPL, dB(A)

75

76

77

77

75

Noise criteria, dB(A)

75

75

75

75

75

[1] SPL = SWL - 10*log(2*PI*r2 ) + façade correction [where PI = 3.1416 and r is the distance of NSR from notional noise source]

[2] The figures are rounded-off to a whole number

[3] Construction work for Pier 8-11 will not overlap with each other

[4] Max SWL is adopted for activity ID P1, P3 and P4 in the calculation for worst-case scenario

Appendix 7.4:
catalogue and SECTIONAL drawing of noise barrier

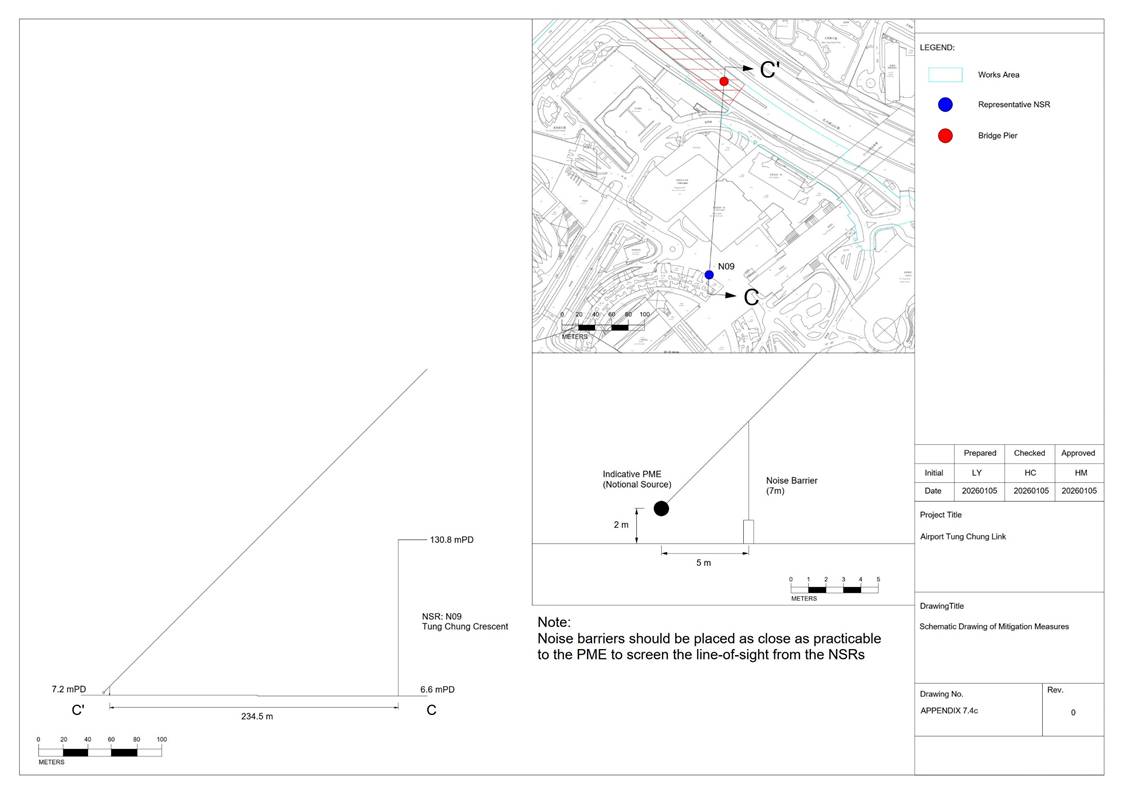

Appendix 7.5:
Construction noise calculations (Mitigated)

Airport Tung Chung Link

Predicted Construction Noise Levels for Representative NSRs

Mitigated Scenario

NSR:

N01 Seaview Crescent

Site Area

Activities

ID

SWL

Dist.

Façade Corr.

SPL

Year

2025

2026

Month

10

11

12

1

2

3

4

5

Project Month

3

4

5

6

7

8

9

10

A

Viaduct 2 (Pier 8 - Pier 11)

P3

120

407

3

63

63

63

63

B

Viaduct 1 (Pier 1 - Pier 7)

P1

119

223

3

67

67

67

67

67

67

C

Viaduct 2 (Pier 12)

P2

118

527

3

59

59

59

59

D

Viaduct 3 (Pier 13 - Pier 20)

P4

124

2382

3

52

52

52

52

52

E

Sea Wall Modification

S1

118

482

3

59

59

59

F

Sea Wall Modification

S1

118

870

3

54

54

54

G

Tung Chung Central Station (Sheet Pile)

T1

113

193

3

62

62

62

62

Total SPL, dB(A)

68

68

70

70

70

Noise criteria, dB(A)

75

75

75

75

75

NSR:

N03 Ling Liang Church E Wun Secondary School

Site Area

Activities

ID

SWL

Dist.

Façade Corr.

SPL

Year

2025

2026

Month

10

11

12

1

2

3

4

5

Project Month

3

4

5

6

7

8

9

10

A

Viaduct 2 (Pier 8 - Pier 11)

P3

120

715

3

58

58

58

58

B

Viaduct 1 (Pier 1 - Pier 7)

P1

119

473

3

61

61

61

61

61

61

C

Viaduct 2 (Pier 12)

P2

118

858

3

54

54

54

54

D

Viaduct 3 (Pier 13 - Pier 20)

P4

124

2575

3

51

51

51

51

51

E

Sea Wall Modification

S1

118

824

3

55

55

55

F

Sea Wall Modification

S1

118

1195

3

51

51

51

G

Tung Chung Central Station (Sheet Pile)

T1

113

332

3

58

58

58

58

Total SPL, dB(A)

62

63

64

64

64

Noise criteria, dB(A)

65

65

65

65

65

NSR:

N05 Ching Chung Hau Po Woon Primary School

Site Area

Activities

ID

SWL

Dist.

Façade Corr.

SPL

Year

2025

2026

Month

10

11

12

1

2

3

4

5

Project Month

3

4

5

6

7

8

9

10

A

Viaduct 2 (Pier 8 - Pier 11)

P3

120

712

3

58

58

58

58

B

Viaduct 1 (Pier 1 - Pier 7)

P1

119

441

3

61

61

61

61

61

61

C

Viaduct 2 (Pier 12)

P2

118

870

3

54

54

54

54

D

Viaduct 3 (Pier 13 - Pier 20)

P4

124

2740

3

51

51

51

51

51

E

Sea Wall Modification

S1

118

865

3

54

54

54

F

Sea Wall Modification

S1

118

1286

3

51

51

51

G

Tung Chung Central Station (Sheet Pile)

T1

113

293

3

59

59

59

59

Total SPL, dB(A)

63

63

65

64

64

Noise criteria, dB(A)

65

65

65

65

65

[1] SPL = SWL - 10*log(2*PI*r2 ) + façade correction [where PI = 3.1416 and r is the distance of NSR from notional noise source]

[2] The figures are rounded-off to a whole number

[3] Construction work for Pier 8-11 will not overlap with each other

[4] Max SWL is adopted for activity ID P1, P3 and P4 in the calculation for worst-case scenario

Airport Tung Chung Link

Predicted Construction Noise Levels for Representative NSRs

Mitigated Scenario

NSR:

N06 Po On Commercial Association Wan Ho Kan Primary School

Site Area

Activities

ID

SWL

Dist.

Façade Corr.

SPL

Year

2025

2026

Month

10

11

12

1

2

3

4

5

Project Month

3

4

5

6

7

8

9

10

A

Viaduct 2 (Pier 8 - Pier 11)

P3

120

704

3

58

58

58

58

B

Viaduct 1 (Pier 1 - Pier 7)

P1

119

437

3

61

61

61

61

61

61

C

Viaduct 2 (Pier 12)

P2

118

867

3

54

54

54

54

D

Viaduct 3 (Pier 13 - Pier 20)

P4

124

2781

3

51

51

51

51

51

E

Sea Wall Modification

S1

118

871

3

54

54

54

F

Sea Wall Modification

S1

118

1304

3

51

51

51

G

Tung Chung Central Station (Sheet Pile)

T1

113

300

3

59

59

59

59

Total SPL, dB(A)

63

63

65

64

64

Noise criteria, dB(A)

65

65

65

65

65

NSR:

N08 Fu Tung Estate

Site Area

Activities

ID

SWL

Dist.

Façade Corr.

SPL

Year

2025

2026

Month

10

11

12

1

2

3

4

5

Project Month

3

4

5

6

7

8

9

10

A

Viaduct 2 (Pier 8 - Pier 11)

P3

120

636

3

59

59

59

59

B

Viaduct 1 (Pier 1 - Pier 7)

P1

119

395

3

62

62

62

62

62

62

C

Viaduct 2 (Pier 12)

P2

118

805

3

55

55

55

55

D

Viaduct 3 (Pier 13 - Pier 20)

P4

124

2826

3

50

50

50

50

50

E

Sea Wall Modification

S1

118

828

3

55

55

55

F

Sea Wall Modification

S1

118

1287

3

51

51

51

G

Tung Chung Central Station (Sheet Pile)

T1

113

272

3

59

59

59

59

Total SPL, dB(A)

64

64

66

65

65

Noise criteria, dB(A)

75

75

75

75

75

NSR:

N09 Tung Chung Crescent

Site Area

Activities

ID

SWL

Dist.

Façade Corr.

SPL

Year

2025

2026

Month

10

11

12

1

2

3

4

5

Project Month

3

4

5

6

7

8

9

10

A

Viaduct 2 (Pier 8 - Pier 11)

P3

120

449

3

62

62

62

62

B

Viaduct 1 (Pier 1 - Pier 7)

P1

119

254

3

66

66

66

66

66

66

C

Viaduct 2 (Pier 12)

P2

118

618

3

57

57

57

57

D

Viaduct 3 (Pier 13 - Pier 20)

P4

124

2767

3

51

51

51

51

51

E

Sea Wall Modification

S1

118

664

3

57

57

57

F

Sea Wall Modification

S1

118

1147

3

52

52

52

G

Tung Chung Central Station (Sheet Pile)

T1

113

196

3

62

62

62

62

Total SPL, dB(A)

68

68

69

68

68

SPL from TCW Station and Tunnels (1201), dB(A)

72

74

74

74

71

Cumulative SPL, dB(A)

73

75

75

75

73

Noise criteria, dB(A)

75

75

75

75

75

[1] SPL = SWL - 10*log(2*PI*r2 ) + façade correction [where PI = 3.1416 and r is the distance of NSR from notional noise source]

[2] The figures are rounded-off to a whole number

[3] Construction work for Pier 8-11 will not overlap with each other

[4] Max SWL is adopted for activity ID P1, P3 and P4 in the calculation for worst-case scenario

Appendix 7.6:
Implementation Schedule of Proposed Mitigation Measures

Implementation Schedule of Mitigation Measures

CNMP Ref.

Proposed Mitigation Measures

Target PME

Implemented by

Location

Period

Environmental Performance Required

Section 7

Use of quieter PME is considered to be a practicable means to mitigate the construction noise impact. Quieter plant is defined as a PME having actual SWL lower than the value specified in the GW-TM.

Refer to table 7.2

Main Contractor

All areas of the Project

Jan 2026 - May 2026

Annex 5, EIAO-TM

Section 7

Quieter Construction Method:

·         Use of Quieter type saw (e.g. diamond wire saw, diamond blade saw) as far as practicable

Excavator-mounted breaker

Main Contractor

Pier 1-7, 12, 13-20

Jan 2026 - Mar 2026

Annex 5, EIAO-TM

Section 7

Quieter Construction Method:

·         Use of Silent piling by Press-in Method

Piling machines for sheet piling work

Main Contractor

Tung Chung Central Station (TCCS) Construction

Jan 2026 - Mar 2026

Annex 5, EIAO-TM

Section 7

Quieter Construction Method:

·         Use of pre-casting and prefabrication technology

N/A

Main Contractor

Sea Wall Modification Construction

Apr 2026 - May 2026

Annex 5, EIAO-TM

Section 7

The use of noise barrier for certain PME could generally provide a 5 dB(A) reduction for movable PME and 10 dB(A) for stationary PME. The barrier material shall be long enough and have no opening or gaps.

Refer to Appendix 7.2

Main Contractor

Pier 1-7, 12

Jan 2026 - May 2026

Annex 5, EIAO-TM

Section 7

Use of Hammer Bracket:

Tuned mass dampers, tailored breaker cloth and noise mitigating plastic skirt on the breaker head of Hydraulic Breaker

Breaker, excavator mounted (hydraulic)

Main Contractor

Pier 1-7, 12

Jan 2026 - May 2026

Annex 5, EIAO-TM

Section 8

Good Site Management Practices

·         Only well-maintained plant should be operated on-site and plants should be serviced regularly during the construction period;

·         Mobile plant, if any, should be sited as far from NSRs as possible;

·         Plant known to emit noise strongly in one direction should, wherever possible, be properly orientated so that the noise is directed away from the nearby NSRs;

·         Use of site hoarding as a noise barrier to screen noise at low level NSRs;

·         Machines and plant that may be used intermittently should be shut down between works periods or should be throttled down to a minimum; and

·         Any material stockpiles and other structures should be effectively utilized, wherever practicable, to screen the noise from on-site construction activities

All PME to be operated

Main Contractor

All areas of the Project

Jan 2026 - May 2026

Annex 5, EIAO-TM

Appendix 7.7:
Extracted CNMP for Tung Chung Line Extension project Submissions under EP-614/2022
