CONTRACT C24W08 AIRPORT TUNG CHUNG LINK
SUBMISSION FOR SILT CURTAIN
DEPLOYMENT PLAN
5 February
2026
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image002.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image004.gif)
Contents
2 CONSTRUCTION WORKS
INVOLVING DEPLOYMENT OF SILT CURTAIN
2.2 Construction
Activities Involving Deployment of Silt Curtain
3 SILT CURTAIN DESIGN
AND CONSTRUCTION SEQUENCE
3.1 Types of Silt
Curtains to be Deployed
3.2 Requirements for
Hanging Type Silt Curtains
3.3 Arrangement for the
Silt Curtain Deployment Location
3.5 Procedures for
Pre-Assembly of Silt Curtain
3.6 Installation of Silt
Curtain
4.1 Deployment of Silt
Curtain
4.3 Procedures for
Adverse Weather Conditions
4.4 Maintenance of Silt
Curtain
5 REGULAR CHECKING AND
MONITORING
LIST OF APPENDICES
APPENDIX A CONSTRUCTION PROGRAMME
INVOLVING DEPLOYMENT OF SILT CURTAIN
APPENDIX B SILT
CURTAIN CATALOGUE AND SPECIFICATION
APPENDIX C SILT
CURTAIN LOCATIONS
APPENDIX D SILT
CURTAIN INSPECTION CHECKLISTS
APPENDIX E IMPLEMENTATION

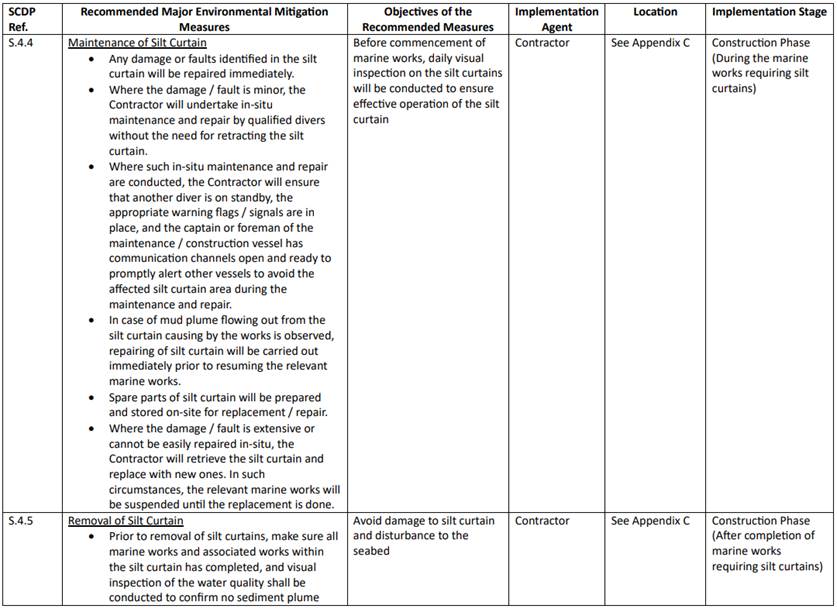

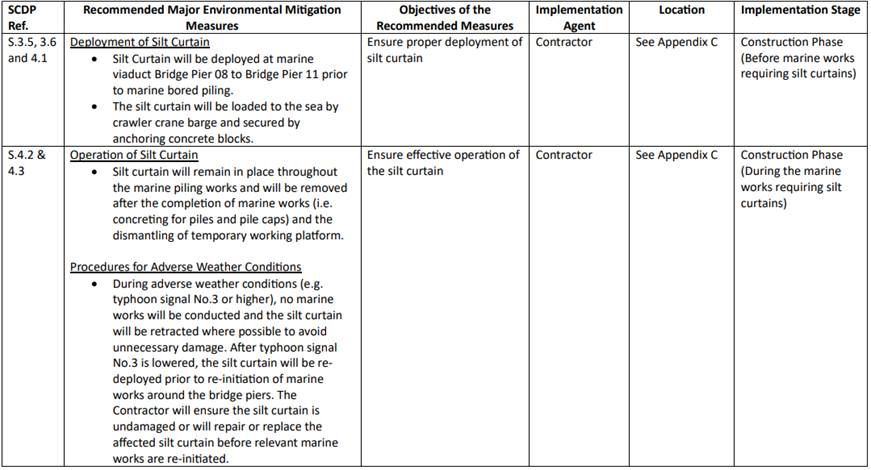

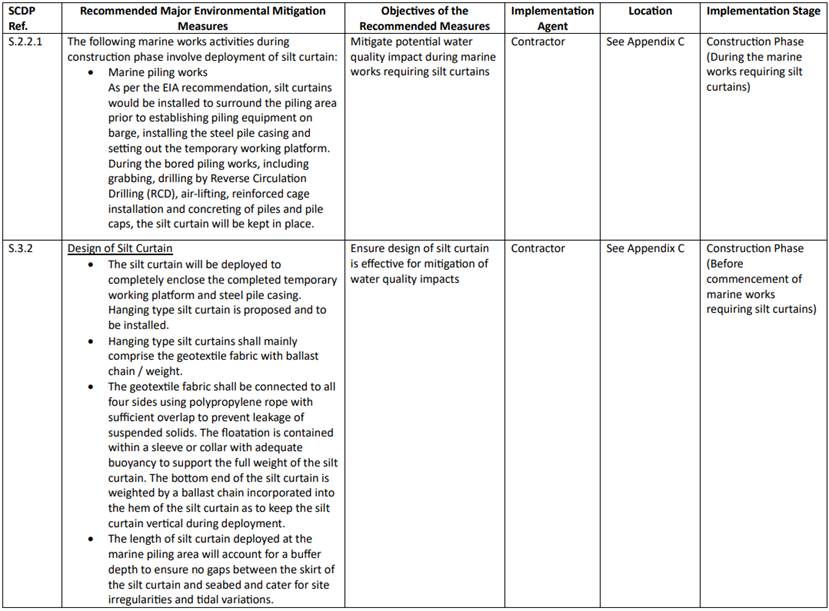

SCHEDULE OF RECOMMENDED MAJOR ENVIRONMENTAL MITIGATION MEASURES
Under the Environmental Impact Assessment
Ordinance, the Environmental Impact Assessment (EIA) Report (Register No.:
AEIAR-254/2023) prepared for the Airport Tung Chung Link Project (the Project)
has been approved by the Environmental Protection Department (EPD). An Environmental Permit No. EP-630/2023 for
the construction and operation of the Project was first granted by Director of
Environmental Protection (“DEP”) to Airport Authority Hong Kong (“AAHK”) on 26
October 2023. Subsequently an application for variation of the EP was submitted
on 3 November 2025 and the current valid EP (No. EP-630/2023/A, hereinafter
known as “the EP”) was issued by EPD on 1 December 2025. Pursuant to Condition
2.13, AAHK shall prepare a Silt Curtain Deployment Plan (“SCDP”) for covering
marine works that involve the deployment of silt curtain under this Project.
This Project consists of constructing a 3.8km
vehicular road, named as the Airport Tung Chung Link (“ATCL”). This road will
extend the passenger transport services using autonomous vehicles (“AV”) from
the Airport City Link (“ACL”) to Tung Chung, aiming to enhance connectivity
between the Hong Kong-Zhuhai-Macao Bridge (“HZMB”) Hong Kong Port (“HKP”),
SKYCITY and Tung Chung. The marine facilities in the waters between Airport
Island and HKP Island, and the spur line running from the HKP Island to connect
the Academy Station are included in the Project EIAR (Register No.
AEIAR-254/2023) and the Project EP (EP No. EP-630/2023/A), however, the
construction of marine facilities and spur line is not included in the current
stage of ATCL construction. The SCDP for remaining marine works will be
provided separately.
Penta-Ocean Construction Company Limited
(“POC”) is the Main Contractor of the Project and responsible for the marine
viaduct construction which situated in a marine area between Lantau Island and
Airport Island. This Silt Curtain Deployment Plan will include the marine
viaduct construction area which situated in a marine area between Lantau Island
and Airport Island. The proposed marine facilities in the waters between
Airport Island and Hong Kong Boundary Crossing Facilities are not included in
this submission.
The Project (under EP Permit No.:
EP-630/2023/A) will comprise:
•
A 2.8km at-grade section along the
eastern coast of Airport Island with intermediate stops;
•
An overall 1km length of viaducts
consisting of three sections (a land viaduct over Tung Chung town centre, a
marine viaduct between Lantau Island and Airport Island and a land viaduct
connecting with ACL at HZMB HKP);
•
An elevated Tung Chung Central
Station (TCCS) near Tat Tung Road;
•
A depot for autonomous vehicle;
•
A promenade; and
•
Leisure supporting facilities, and
the associated ancillary buildings and facilities.
As mention in Section 1.1, the construction of
marine facilities and spur line of ATCL (including Academy Station) as stated
in the Project EIAR and the Project EP are not included in the current stage of
ATCL construction, and was thus not included in this SCDP”.
As specified in Condition 2.13 of the EP:
“The Permit Holder shall, no later than 2
months before the commencement of marine works involving deployment of silt
curtains of the Project, deposit 3 hard copies and 1 electronic copy of a silt
curtain deployment plan (SCDP) with the Director. The Plan shall include the
construction programme of marine works and details on the design, location,
operation and maintenance of silt curtain(s) to be deployed during the marine
works. The Plan shall be fully and properly implemented.”
This SCDP has been prepared in accordance with
the EP requirements and details the requirements for implementation of silt
curtains during the Project construction phase. This Silt Curtain Deployment
Plan will include the marine viaduct construction area which situated in a
marine area between Lantau Island and Airport Island.
Following the introductory section, the SCDP
is structured as follows:
Section 2 Construction
Works involving Deployment of Silt Curtain
Section 3 Silt
Curtain Design and Location
Section 4 Operation
and Maintenance
Section 5 Regular
Checking and Monitoring
Deployment of silt curtain has been
recommended for marine construction in the approved ATCL EIA report. The marine
works activities during construction phase as stipulated in Section 2.2 will
involve deployment of silt curtain.
The deployment of silt curtain will be
commenced on 1 March 2026, and the marine piling works will be commenced on 1

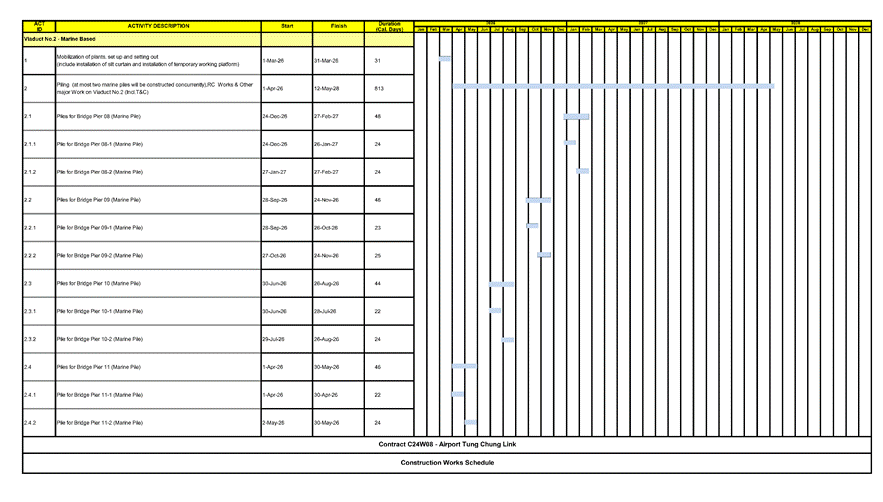

April 2026. Construction programme involving deployment of silt curtain can be
referred to the Appendix A.
The construction of marine viaduct section
would involve the installation of 4 set of bridge piers (2 piles for each set, totaled 8 piles) across the Tung Chung Navigation Channel.
A temporary working platform would be installed after installation of silt
curtain(s) to surround the active marine works area for the marine viaduct and
all subsequent piling work would be conducted by piling plants on top of the
temporary working platform. Bored piling for the marine viaduct crossing the
Tung Chung Navigation Channel would be conducted with the silt curtain remains
in place.
Hanging type silt curtain will be deployed at

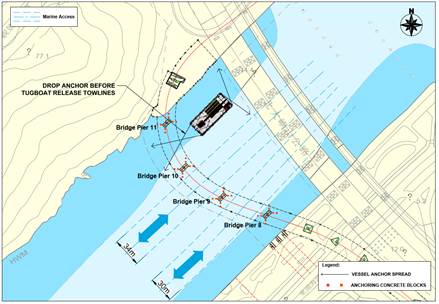

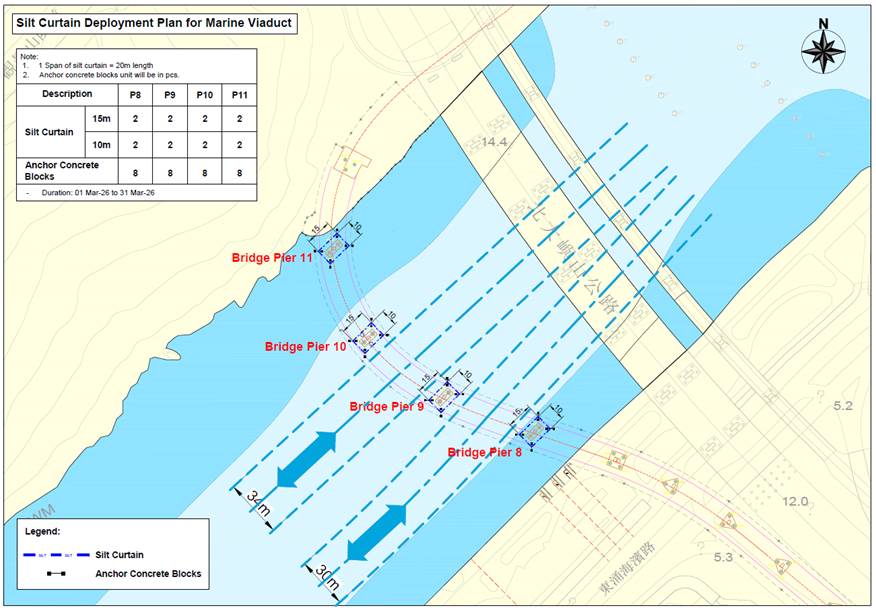

the surrounding of each set of bridge piers (Bridge Pier 8 to Bridge Pier 11)

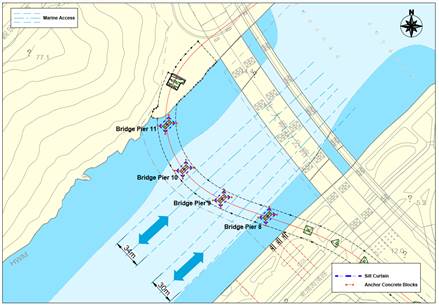

for a marine viaduct between Lantau Island and Airport Island. Total of 4
individual silt curtains will be provided for the marine viaduct construction
works.

Appendix C shows
the site location and layout plan of the proposed marine works.
As per the approved ATCL EIA Section 5.7.1.1
recommendation, silt curtains would be installed to surround the piling area
prior to establishing piling equipment on barge, installing the steel pile
casing and setting out the temporary working platform. The silt curtain will be
kept in place throughout the bored piling works, including grabbing, drilling
by Reverse Circulation Drilling (RCD), airlifting, reinforced cage installation
and concreting for piles and pile caps.
The construction of marine viaduct section
would involve the installation of 4 set of bridge piers, Bridge Pier 8 to
Bridge Pier 11 (2 piles for each set, totaled 8
piles) across the Tung Chung Navigation Channel. At most two marine piles will
be installed/constructed concurrently at the viaduct works area across Tung
Chung Navigation Channel during the construction phase. After installation of
silt curtain(s) to surround the active marine works area for the marine
viaduct, a temporary working platform that sits on support casings (with or
without reinforcing by mini-piles) would be installed. The support casings will
be positioned to the seabed by vibratory hammer from a barge. Such operation is
expected to result in limited level of localized disturbance to bottom
sediment, particularly when controlled by the surrounding silt curtain. In case
mini-piles support is needed, the temporary support casings will be lowered
until reaching the rock head until rock socket is formed. After securing the
support casings, a temporary working platform would be installed on top of the
casings and all subsequent piling works would be conducted by piling plants on
top of the temporary working platform. Bored piling for the marine viaduct
crossing the Tung Chung Navigation Channel would be conducted with the silt
curtain remains in place.
Hanging Type silt curtain is proposed to be
installed around Bridge Pier 8 to Bridge Pier 11. The following sub-sections
outline the technical requirements of the silt curtain.

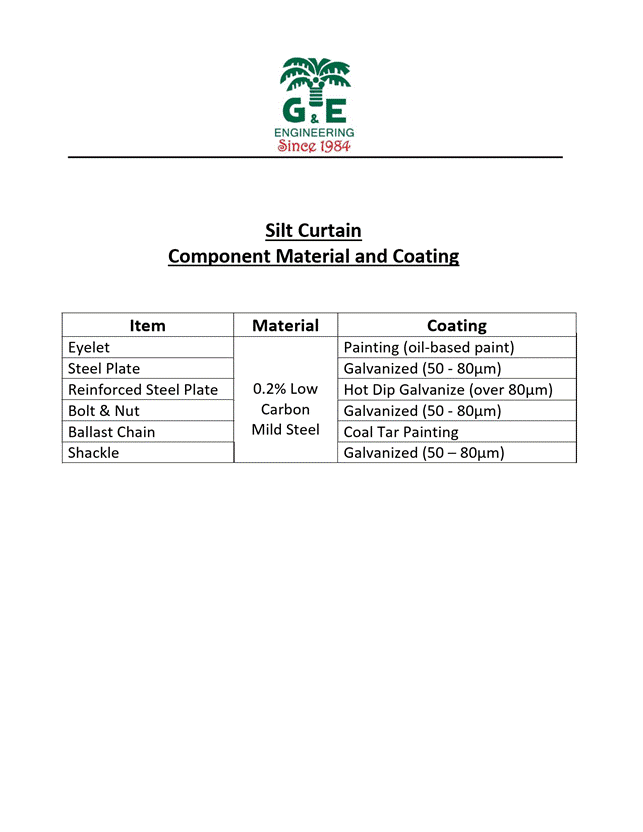

Hanging Type silt curtains mainly comprise the
geotextile fabric with ballast chain / weight and floatation. The geotextile fabric shall be connected
all four sides using polypropylene rope with sufficient overlap to prevent
leakage of suspended solids. The floatation is contained within a sleeve or
collar with adequate buoyancy to support the full weight of the silt curtain.
The bottom end of the silt curtain is weighted by a ballast chain incorporated
into the hem of the silt curtain as to keep the silt curtain vertical during
deployment.
The length of silt curtain deployed at the
marine piling area will account for a buffer depth to ensure no gaps between
the skirt of the silt curtain and seabed and cater for site irregularities and
tidal variations.
To ensure the quality of silt curtain, the
supplier must be quality certified (i.e. ISO 9001 or equivalent) and relevant
project references / records of field tests demonstrating the silt curtains
applicability for deployment in open sea marine environments and conditions
comparable to those in Hong Kong waters shall be provided. Details are provided
in Appendix B.
Before installation of temporary working
platform commences, deployment of silt curtain is necessary. Silt curtain will
be installed around the works area for demarcation and prevention of water

quality impacts. The marine viaduct works area is shown in Appendix C.
A Bathymetric Survey will be conducted to
check the depth of the seabed and existing seabed condition using the Multibeam
Sonar. The Survey coverage will be within the works area of the marine viaduct.
The primary purpose of this survey is to detect any vertical anomalies
(high-spots or low-spots) present on the seabed within the work area so that
can pre-plan the working methodology on the marine viaduct. Aside from
pre-planning of the working methodology, the length of the silt curtain can be

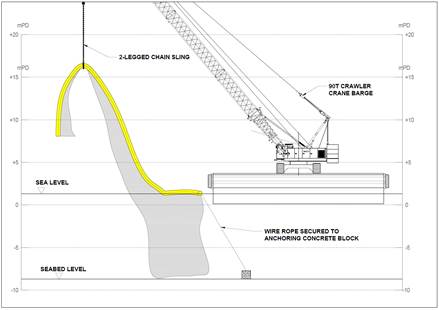

determined. The sample Bathymetric Survey Record is shown in Figure 3.1.
Figure 3.1: Sample Report of
Bathymetric Survey on the Marine Viaduct
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image006.jpg)
1.
The pre-assembly of silt curtain will be
conducted on deck of a 90T Crawler Crane Barge.
2.
A 15m span of pre-assembled silt curtain will
be connected to a 10m span of pre-assembled silt curtain to form a 25m long
silt curtain section. Two 25m long silt curtain sections will be connected to
form a 50m long silt curtain (2 nos. of 15m span silt curtain and 2 nos. of 10
m span silt curtain). Each connection will use the D-shackles and Polypropylene
rope for stitching as shown in Figure 3.2.
3.
Each pre-assembled silt curtain will be
connected to another span of silt curtain using a D-shackle at the top, middle,
and bottom connection points of the steel end plates.
4.
The eyelets of the pre-assembled silt curtain
will be threaded with a polypropylene rope in a zigzag pattern to connect the
sections.
5.
A ballast chain will be inserted into the
chain pocket at the bottom of the pre-assembled silt curtain to provide weight
and stability.
6.
To safely secure the ballast chain pocket, a
larger D-shackle will be attached to the lowest point of the connecting steel
plate to support the weight of the ballast chain and avoid wear and tear on the
ballast chain pocket.
Figure 3.2: Details of Stitching Two Spans of
Pre-assembled Silt Curtain
PRE-ASSEMBLED
SILT CURTAIN
![]()
![]()
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image010.jpg)
7.
After interconnecting all 4 spans of silt
curtain, fold the assembled silt curtain, starting from the ballast chain
pocket and working up towards the floatation end as shown in Figure 3.3.

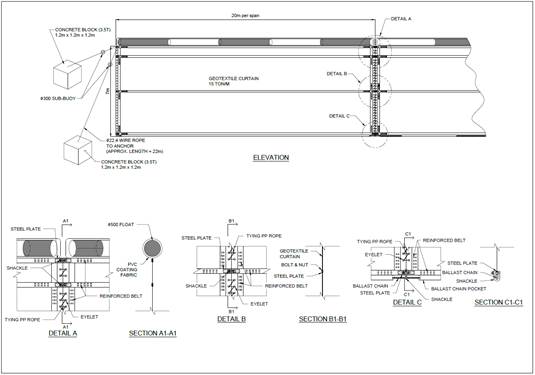

Figure 3.3: Folded Silt Curtain
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image012.jpg)
1.
Anchoring concrete blocks will be
used to keep the silt curtain vertical during deployment and would be settled
at its designated positions before launching the silt curtain into the sea.
2.
Four sets of pre-assembled silt
curtain would be loaded to the 90T crawler crane barge and towing into the
marine viaduct area by tugboat.
3.
Upon reaching the marine viaduct
area, the crawler Crane will drop its anchor on the seabed. The tugboat will
release its towlines once all 4 anchors of the crawler crane barge has been set
on the seabed as shown in Figure 3.4.
Figure 3.4: 90T Crawler Crane Anchor Drop at
the Working Vicinity
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image014.jpg)
4.
The crawler crane barge will moor
towards the silt curtain deployment locations and load down the folded silt
curtain into the sea. Sub-buoys will be installed on the silt curtain first
before the diver dives down and secure the silt curtain to the anchoring
concrete blocks. Illustration of silt curtain set up is in Figure 3.5.

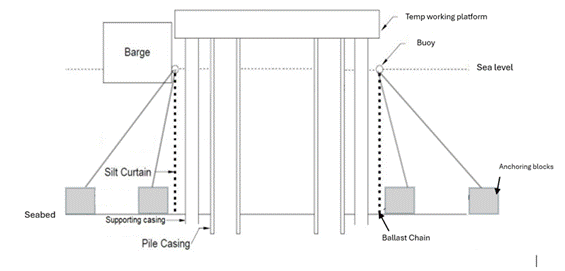

Figure 3.5: Diagram of Silt
Curtain Set Up
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image016.gif)
5.
The crawler crane will navigate
the position of the silt curtain (see Figure 3.6) to its next position
then repeat step until completing all 4 silt curtain positions as shown in Figure
3.7.
Figure 3.6: Navigating the Silt
Curtain
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image018.jpg)
Figure 3.7: Completed Installation of Silt
Curtain
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image020.jpg)
Silt curtain will be deployed at marine
viaduct Bridge Pier 8 to Bridge Pier 11 prior to marine bored piling. The
details of work sequence can refer to Section 3.5 to 3.6.
Silt curtain will remain in place throughout
the marine piling works and will be removed after the completion of marine
works (i.e. concreting for piles and pile caps) and the dismantling of
temporary working platform. Regular checking and monitoring will be carried out
during the operation of the silt curtain (see Section 5).
During adverse weather conditions (e.g.
typhoon signal No.3 or higher), no marine works will be conducted and the silt
curtain will be retracted where possible to avoid unnecessary damage. After
typhoon signal No.3 is lowered, the silt curtain will be re-deployed prior to
re-initiation of marine works around the bridge piers.
The Contractor will ensure the silt curtain is
undamaged or will repair or replace the affected silt curtain before relevant
marine works are re-initiated. Re-deployment
of silt curtains where required, shall follow the procedures specified in
Section 3.5 to 3.6.
Before commencement of marine works, daily
visual inspection on the silt curtains will be conducted, any damage or faults
identified in the silt curtain will be repaired immediately. Where the damage /
fault is minor, the Contractor will undertake in-situ maintenance and repair by
qualified divers without the need for retracting the silt curtain. Where such
in-situ maintenance and repair are conducted, the Contractor will ensure that
another diver is on standby, the appropriate warning flags / signals are in
place, and the captain or foreman of the maintenance / construction vessel has
communication channels open and ready to promptly alert other vessels to avoid
the affected silt curtain area during the maintenance and repair. In case of
mud plume flowing out from the silt curtain causing by the works is observed,
repairing of silt curtain will be carried out immediately prior to resume the
relevant marine works.
Spare parts of silt curtain will be prepared
and stored on-site for replacement / repair. Where the damage / fault is
extensive or cannot be easily repaired in-situ, the Contractor will retrieve
the silt curtain and replace with new ones. In such circumstances, the relevant
marine works will be suspended until the replacement is done.
Prior to removal of silt
curtains, ensure all marine works and associated works (as mentioned in section
4.2 above) within the silt curtain has completed and visual inspection of the
water quality shall be conducted to confirm no sediment plume remaining within
the works area before commencing silt curtain removal. The silt curtain will be
lifted carefully to avoid stirring up the seabed and will be removing by a
crawler crane.
Regular checking of the silt curtain will be
conducted throughout the deployment of the silt curtain. The two types of
checks that will be conducted are:
●
Visual – the Contractor to check
that the silt curtains are maintained in the correct positions with no obvious
defects / entanglement, the marker buoys / lights (where applicable) are
present and operational, and there is no observable muddy water passing through
the silt curtain system. Any floating refuse trapped by the silt curtain will
also be removed as part of the visual inspection.
●
Diver – for conducting more
thorough underwater inspections to check that the silt curtain fabric is
intact, the silt curtain depths are correct, and there is no damage / breakage
in load lines.
The checking frequency is summarised in Table

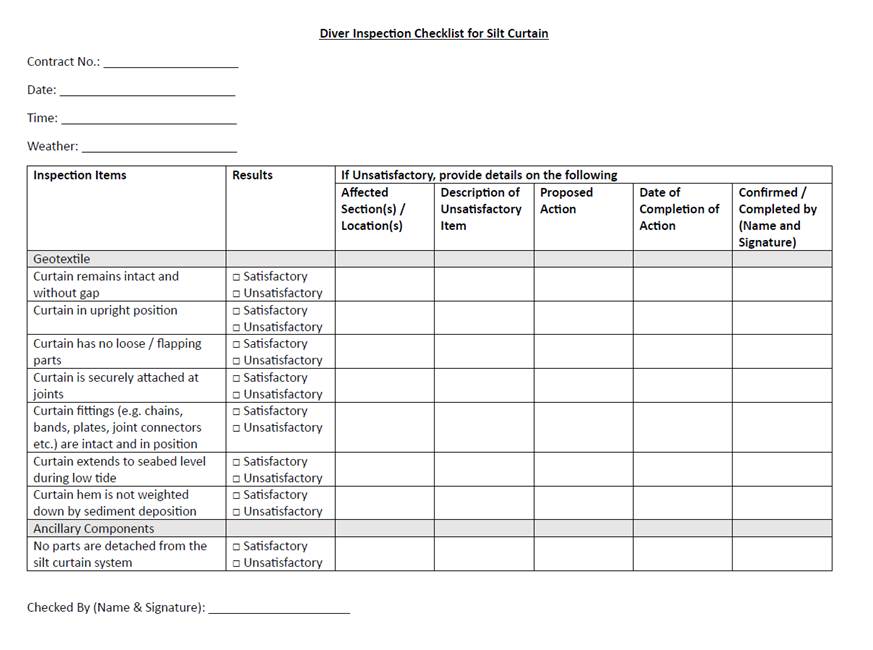

5.1. All checks will follow the inspection checklists shown in Appendix D
and will be appropriately signed off by the Contractor.
Table
5.1: Inspection Requirement and Frequency
|
Inspection Requirement |
Purpose |
Visual Inspection Frequency |
Diver Inspection Frequency |
|
Upon initial installation |
To confirm the silt curtain has been properly installed |
Daily |
Once |
|
During operation |
To maintain regular check of silt curtain performance / integrity |
Quarterly |
|
|
When there is observed / suspected sediment release |

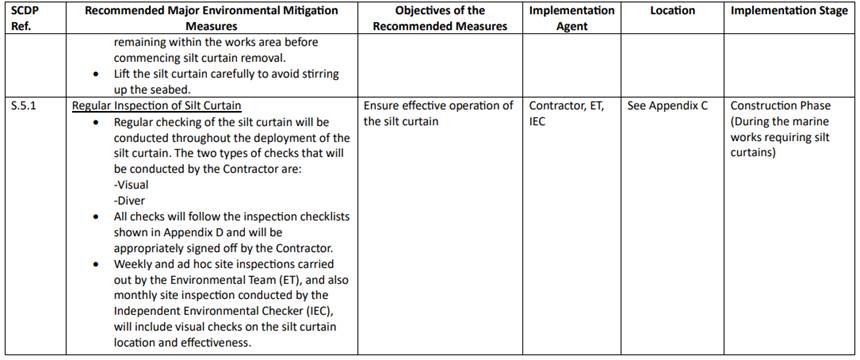

To identify cause of sediment release and confirm any remedial
actions taken |
At least once for each instance |
|
|
Upon re-installation (where applicable) |
To confirm the silt curtain has been properly re-installed |
Once for each instance of re-installation |
Weekly and ad hoc site inspections carried out
by the Environmental Team (ET), and also monthly site inspection conducted by
the Independent Environmental Checker (IEC), will include visual checks on the
silt curtain location and effectiveness. Where the silt curtains deployed are
identified by the ET and / or IEC to be ineffective or inadequate for
controlling sediment release, the Contractor will make appropriate adjustments
or provided additional silt curtains as necessary to improve and meet the water
quality requirements of the Project.
All inspections carried out by the Contractor
will be recorded on the silt curtain inspection checklists are shown in Appendix
D. All checklists will be signed by the Contractor and kept on-board the
responsible maintenance / construction vessel and made available to the ET and
IEC upon request for checking and auditing purpose. Diver inspection records
will also be signed by the qualified diver. A summary of the records of the
daily visual and the diver inspections including photographic records, as well
as any rectification action taken, will be included in the Contractor’s monthly
environmental reports.
An implementation schedule of key requirement
of relevant mitigation measures is provided in Appendix E.
APPENDIX A
CONSTRUCTION PROGRAMME INVOLVING DEPLOYMENT OF SILT CURTAIN
APPENDIX B
SILT CURTAIN CATALOGUE AND SPECIFICATION
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image024.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image026.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image028.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image030.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image032.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image034.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image036.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image038.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image040.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image042.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image044.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image046.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image052.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image054.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image056.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image058.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image060.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image062.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image064.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image066.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image068.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image070.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image072.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image074.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image076.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image078.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image080.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image082.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image084.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image086.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image088.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image090.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image092.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image094.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image096.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image098.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image100.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image102.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image104.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image106.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image108.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image110.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image112.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image114.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image116.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image118.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image120.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image122.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image124.gif)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image126.gif)
APPENDIX C
SILT CURTAIN LOCATIONS
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image128.jpg)
APPENDIX D
SILT CURTAIN INSPECTION CHECKLISTS
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image132.jpg)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image134.jpg)
APPENDIX E
IMPLEMENTATION SCHEDULE OF RECOMMENDED MAJOR ENVIRONMENTAL MITIGATION
MEASURES

%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image136.jpg)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image138.jpg)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image140.jpg)
%2000107E_Submission%20of%20Silt%20Curtain%20Deployment%20Plan%20(clean).files/image142.jpg)
