Airport
Tung Chung Link
Construction
Noise Management Plan
1 April 2026
Ref: RT25358-AC-01E
Prepared
by:
BeeXergy Consulting Limited (BXG)
in association with
Penta-Ocean Construction Co., Ltd
|
Prepared and Checked By: |
|
Approved by |
|
|
|
|
|
Chuh Augustine
Harmony |
|
FS Cheung |
|
Certified Noise
Modelling Professional |
|
Acoustic Expert, FHKIOA |
|
HKIQEP Membership
No.: PM0506 |
|
HKIOA Membership No.: 008 |
Disclaimer:
|
n
This report is prepared and checked by acoustic professional including at least one Certified Noise Modelling
Professional as recognised by the Hong Kong Institute of Qualified
Environmental Professional Limited or other professional as agreed by the
Director. This report is prepared in association with Penta-Ocean
Construction Co., Ltd with all reasonable skill to
the best of our knowledge, incorporating our Terms and Conditions and taking
account of the resources devoted to it by agreement with the client. n
We disclaim any responsibility to the client and
others in respect of any matters outside the project scope. n
This report is confidential to the client and we accept no responsibility of whatsoever
nature to third parties to whom this report, or any part thereof, is made
known. Any such party relies upon the report at their own risk. |

Table of Content
6. Identification of Noise Sensitive Receivers
7. Construction Noise Impact Assessment
Appendix A: CONSTRUCTION
Programme
Appendix B: proposed
construction plant inventory
Appendix C: Construction noise
calculations (Unmitigated)
Appendix D: Reference to existing Noise bArrier and
Section Drawing of existing Structures/Barriers
Appendix E: catalogue and
SECTION drawing of noise barrier
Appendix F: Construction noise
calculations (Mitigated)
Appendix G: Implementation
Schedule of Proposed Mitigation Measures
Appendix H: Extracted CNMP for
Tung Chung Line Extension project Submissions under EP-614/2022
The EIA Report for Airport Tung Chung Link Project (the
ATCL Project) (AEIAR-254/2023) was approved on 26 October 2023. The latest Environmental
Permit (EP) (EР-630/2023/A) was issued on 1 December 2025. According to Clause
2.12 of the EP, the Permit Holder shall submit a Construction Noise Management
Plan (CNMP) for implementing construction noise mitigation measures no later
than 2 months before the commencement of construction works of the Project to
the Director of Environmental Protection (DEP).
As stipulated in Clause 2.12 of the EP, 3 hard
copies and 1 electronic copy of the CNMP shall, no later than 2 months before
the commencement of construction works of the Project, be deposited with the
DEP. If there is any change to the construction noise mitigation measures
and/or plant inventory recommended in the submitted CNMP, 3 hard copies and 1
electronic copy of an updated CNMP shall, no later than 1 month before the
implementation of any such change, be deposited with the DEP. The CNMP and
updated CNMP shall identify the noise source inventory and assess the
effectiveness of construction noise mitigation measures, including the use of
quieter powered mechanical equipment, quieter construction methods, noise
barriers, enclosures and insulation fabric as recommended in the approved EIA
Report (Register No. AEIAR-254/2023) for mitigating the construction noise
impact of the Project. The CNMP and updated CNMP shall include an
implementation schedule in table form to clearly list out the mitigation measures
to be implemented, and the implementation party, location, timing, and
environmental performance required for implementation of the mitigation
measures. The CNMP and updated CNMP shall be prepared and checked by a
Certified Noise Modelling Professional as recognized by the Hong Kong Institute
of Qualified Environmental Professionals Limited or other professional as
agreed by the Director, certified by the ET Leader and verified by the IEC as
conforming to the relevant information and recommendations of the approved EIA
Report (Register No. AEIAR-254/2023). All mitigation measures recommended and
requirements specified in the CNMP and the updated CNMP shall be fully
implemented.
This CNMP will be regularly reviewed and updated to
reflect any changes in construction work or site arrangements, ensuring
continuous compliance. This CNMP focused on the construction works
conducted during Feb 2026 to May 2026 only and the remaining construction
period is still under planning and subject to change. The Contractor will
submit other CNMP for the remaining construction period once the details become
available. If there is any update on the construction works
conducted from Feb 2026 to May 2026, a revised CNMP will be submitted to the
EPD.
The Noise Control Ordinance (NCO) (Cap. 400)
provides the statutory framework for noise control.
The Environmental Impact Assessment Ordinance (EIAO) (Cap. 499) provides the
framework for assessment of the noise impact for designated projects
Reference to the EIAO and the relevant technical
memoranda has been made for the assessment of noise impacts. Annexes 5 and 13
of the Technical Memorandum on Environmental Impact Assessment Process (EIAO-TM)
set out the criteria and guidelines for evaluating noise impacts. Assessment
procedures and standards are set out in the following technical memoranda and
Guidance Note:
·
Technical Memorandum on Environmental Impact Assessment Process (EIAO-TM);
·
Technical Memorandum on Noise from Construction Work in Designated Areas
(DA-TM);
·
Technical Memorandum on Noise from Construction Work other than
Percussive Piling (GW-TM);
·
Technical Memorandum on Noise from Percussive Piling (PP-TM);
·
EIAO Guidance Note – Preparation of Construction Noise Impact Assessment
under the Environmental Impact Assessment Ordinance (GN9/2023).
The
Technical Memorandum on Environmental Impact Assessment Process (EIAO-TM)
stipulates criteria of 65 – 75dB(A) for daytime construction activities, as
shown in Table 3.1.
Table 3.1
Noise standards for
daytime construction activities
|
Use |
Noise Standards, Leq
(30min) dB(A) |
|
0700 – 1900 hours on any day not being a Sunday or
general holiday |
|
|
All domestic premises, Temporary housing
accommodation, Hostels, Convalescent homes, and Homes for the aged |
75 |
|
Places of public worship, Courts of law, and Hospitals and medical
clinics |
70 |
|
Educational
institutions (including kindergartens and nurseries) |
70 65
(During Examination) |
Notes:
[1] The above
standards apply to uses which rely on opened windows for ventilation and are
assessed at 1m from the external façade.
[2] A Construction
Noise Permit shall be required for carrying out relevant construction work
during restricted hours under the Noise Control Ordinance. In case the
applicant would like to evaluate whether carrying out relevant construction
works during restricted hours under the Noise Control Ordinance is feasible or
not in the context of programming construction works, reference should be made
to relevant technical memoranda issued under the Noise Control Ordinance.
The
assessment of noise impacts from the construction (excluding percussive piling)
of the Project has been based on the methodology given in Annex 13 of the
EIAO-TM. The typical approach is summarized as follows:
The
Contractor has confirmed this scope of work, ensuring the noise assessment is
focused and accurate. No construction activities other than specified below are
permitted during this specific period.
The proposed
construction works will be carried out only between 07:00 and 19:00 hours on any day not being a
Sunday or general holiday. It is noted
that Marine Department Notices (MDN) is required for permission of entering the
site portion at sea area which will take usually 3-6 months for the issuance of
MDN. Hence, the commencement of construction works at sea area will be subject
to change and depend on the progress of obtaining MDN. The Contractor shall
submit other CNMP reports for the any changes in construction period. As

advised by the Contractor and broadly indicated in the construction programme in Appendix A, the major construction
works of the Project during Feb 2026 to May 2026 include:
The Project site is situated between Tung Chung town centre and Hong

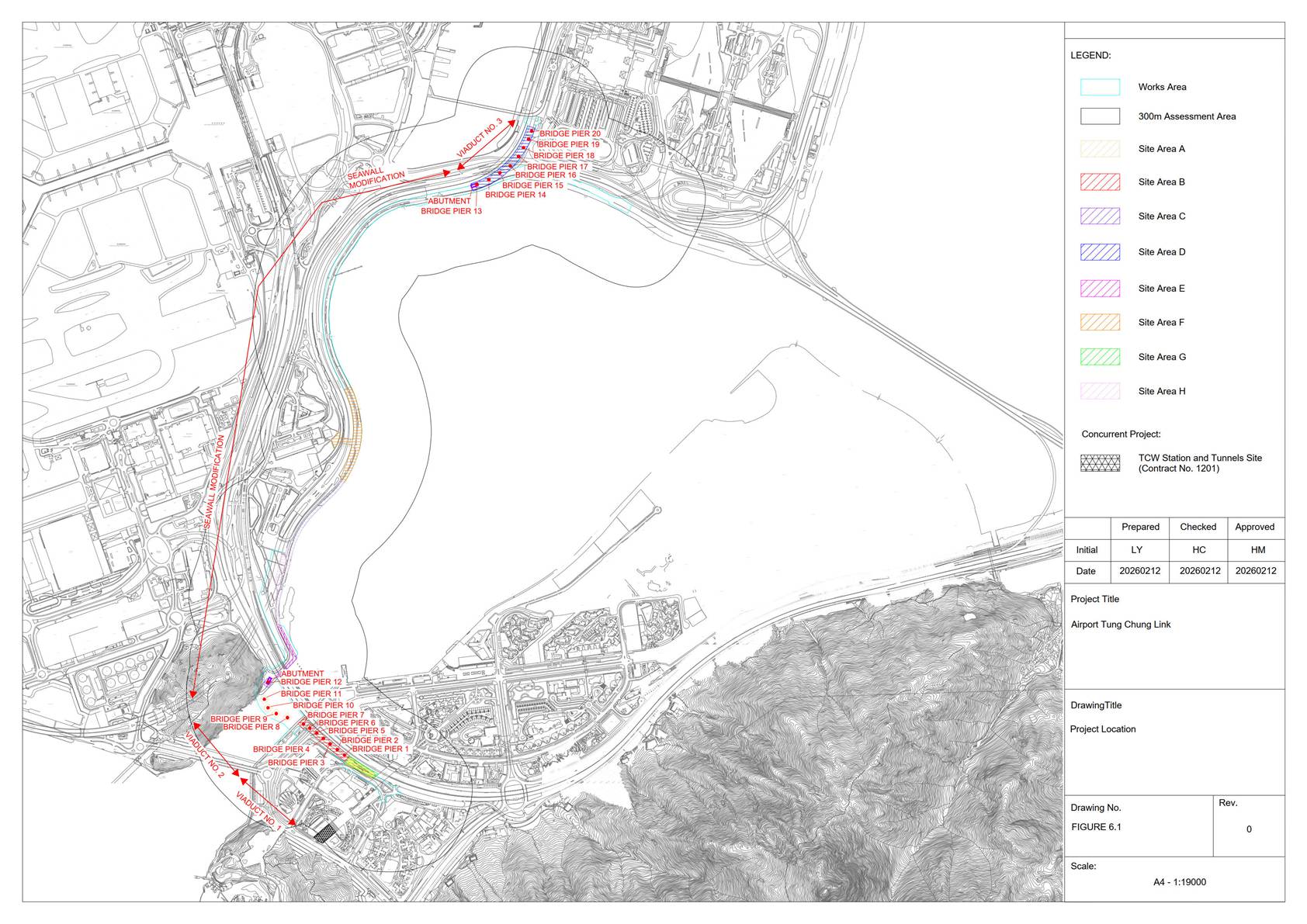

Kong Port (HKP) Island. The location of the Project is shown in Figure 6.1.
The noise sensitive receivers in the assessment area mainly comprise
residential uses and the government, institution or community uses at Tung
Chung town centre. The assessment area for noise impact generally include areas within 300m from the boundary of the Project
and the works of the Project. Noise Sensitive Receivers (NSRs) within a distance of 300m from the boundary of the Project and the
works of the Project have been identified. NSRs located within the first layer
from the Project site and having openable windows for ventilation were selected
as representative NSRs for assessment.
The identified existing, committed and planned NSRs, if any, within the

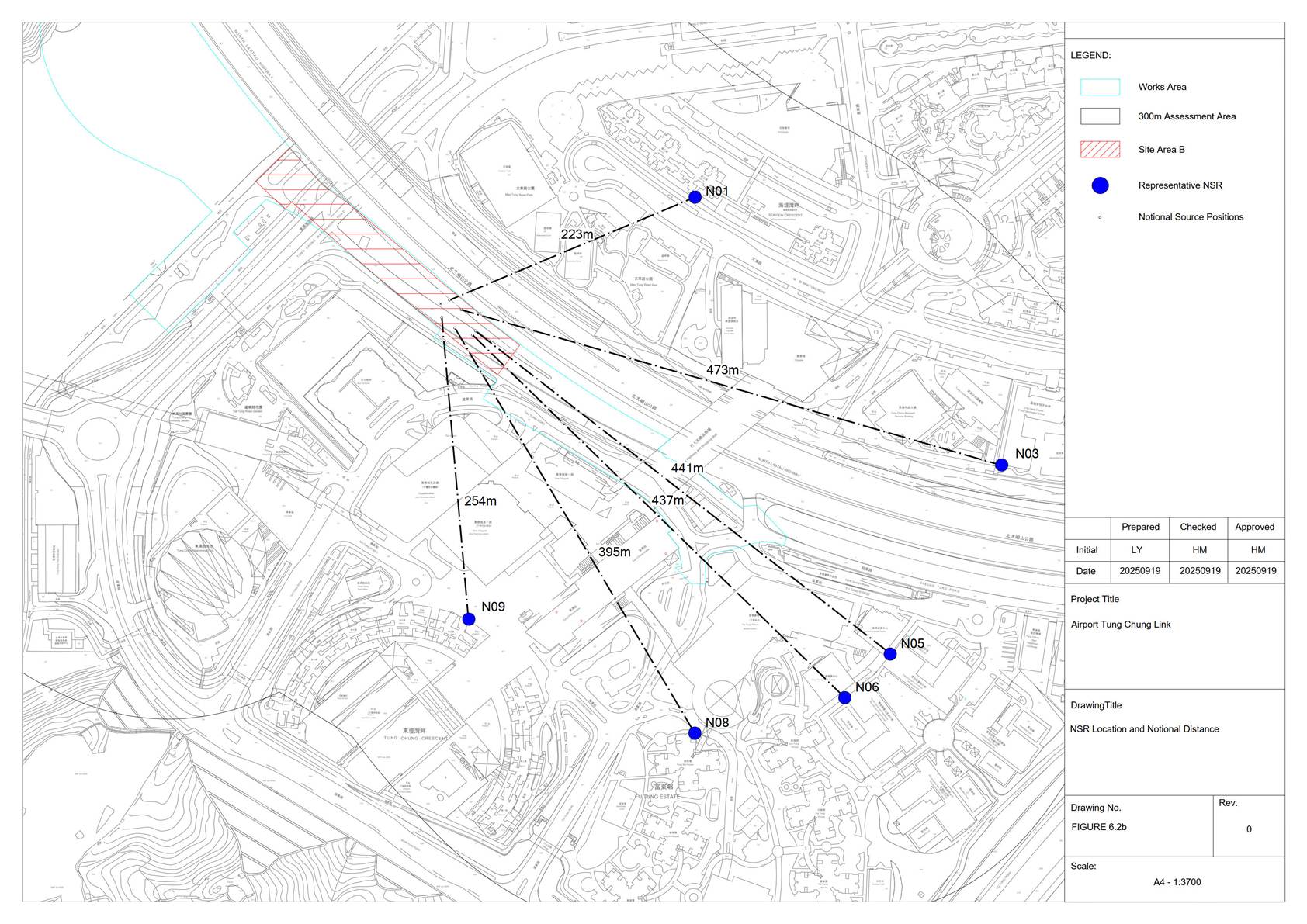

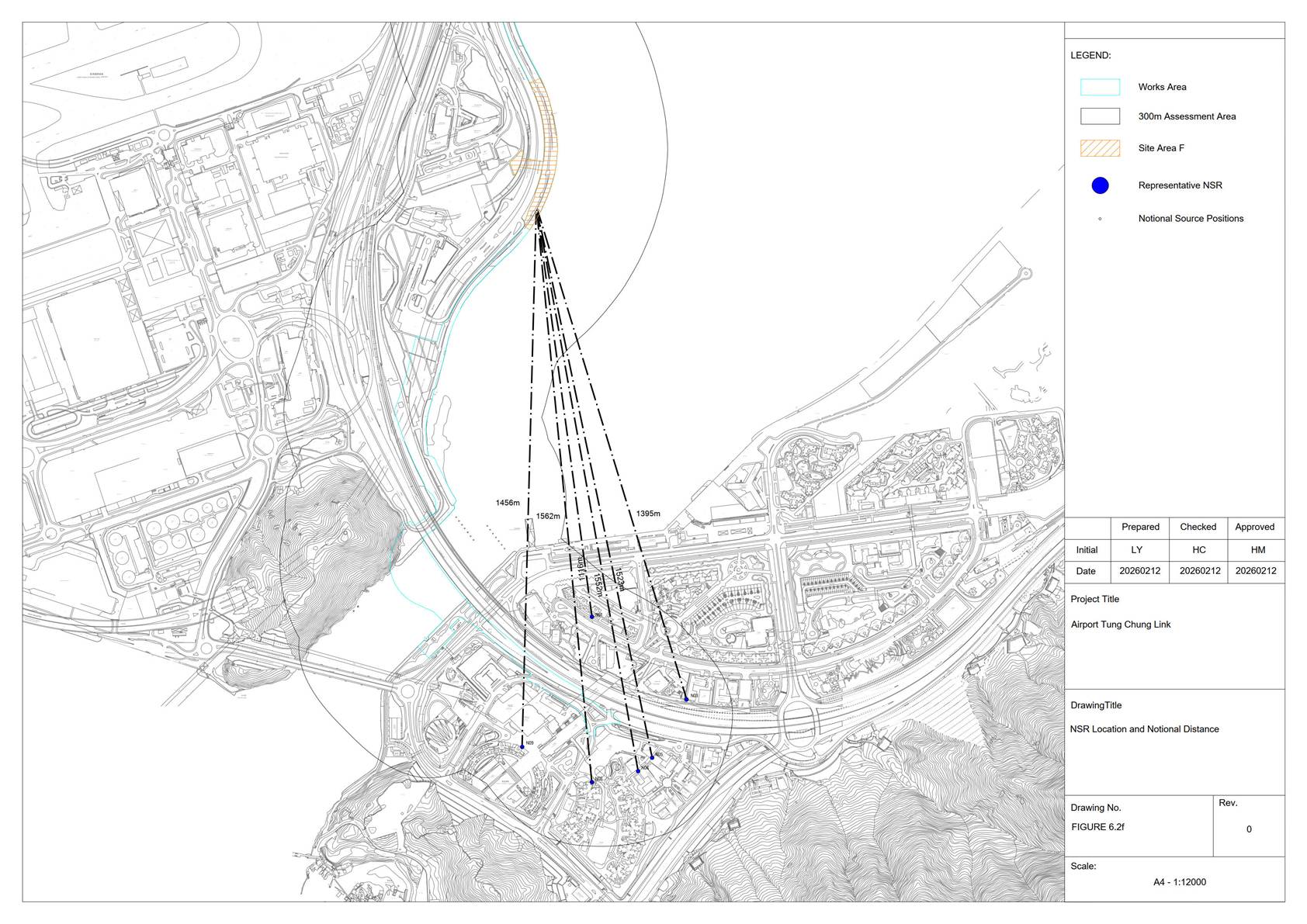

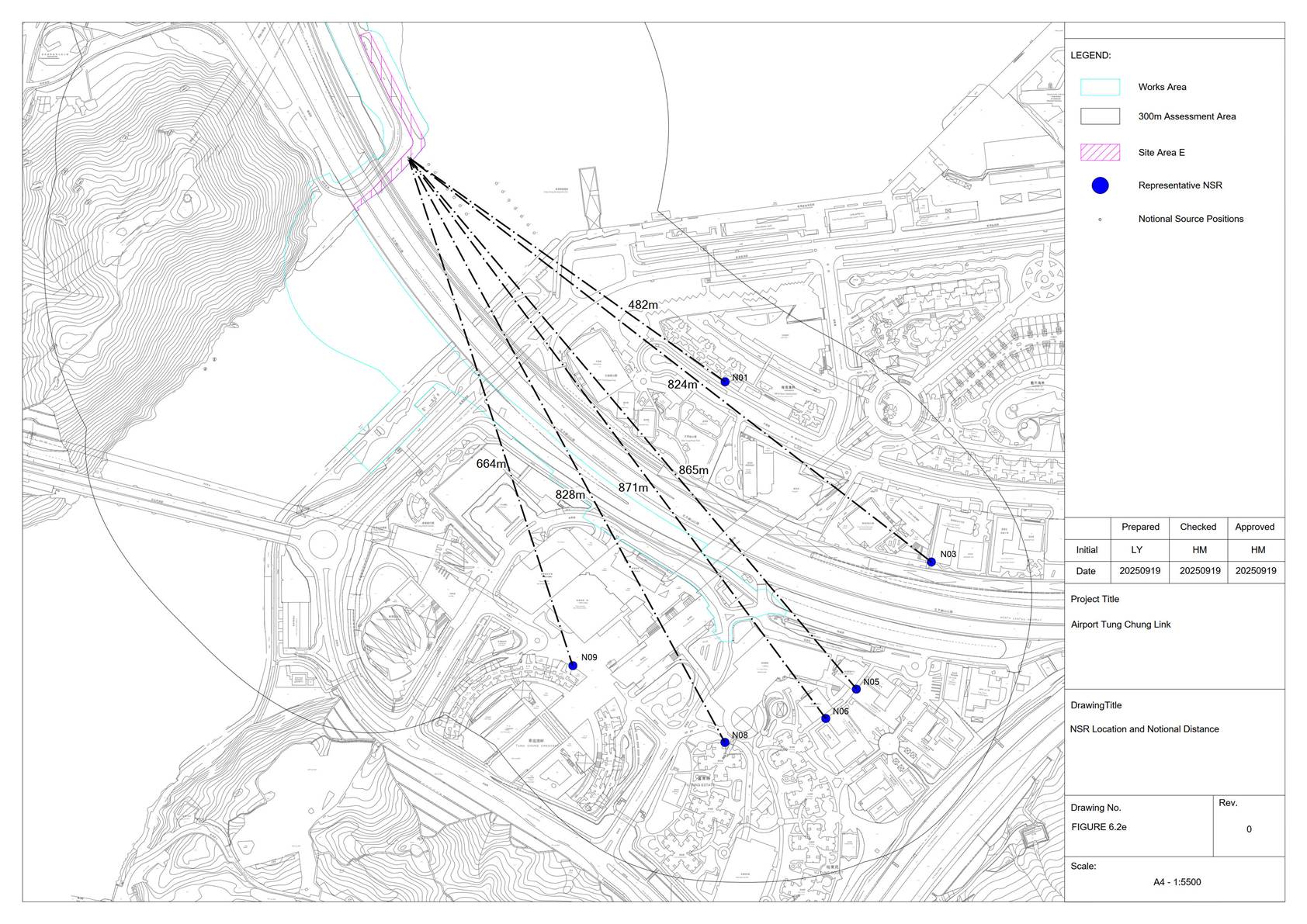

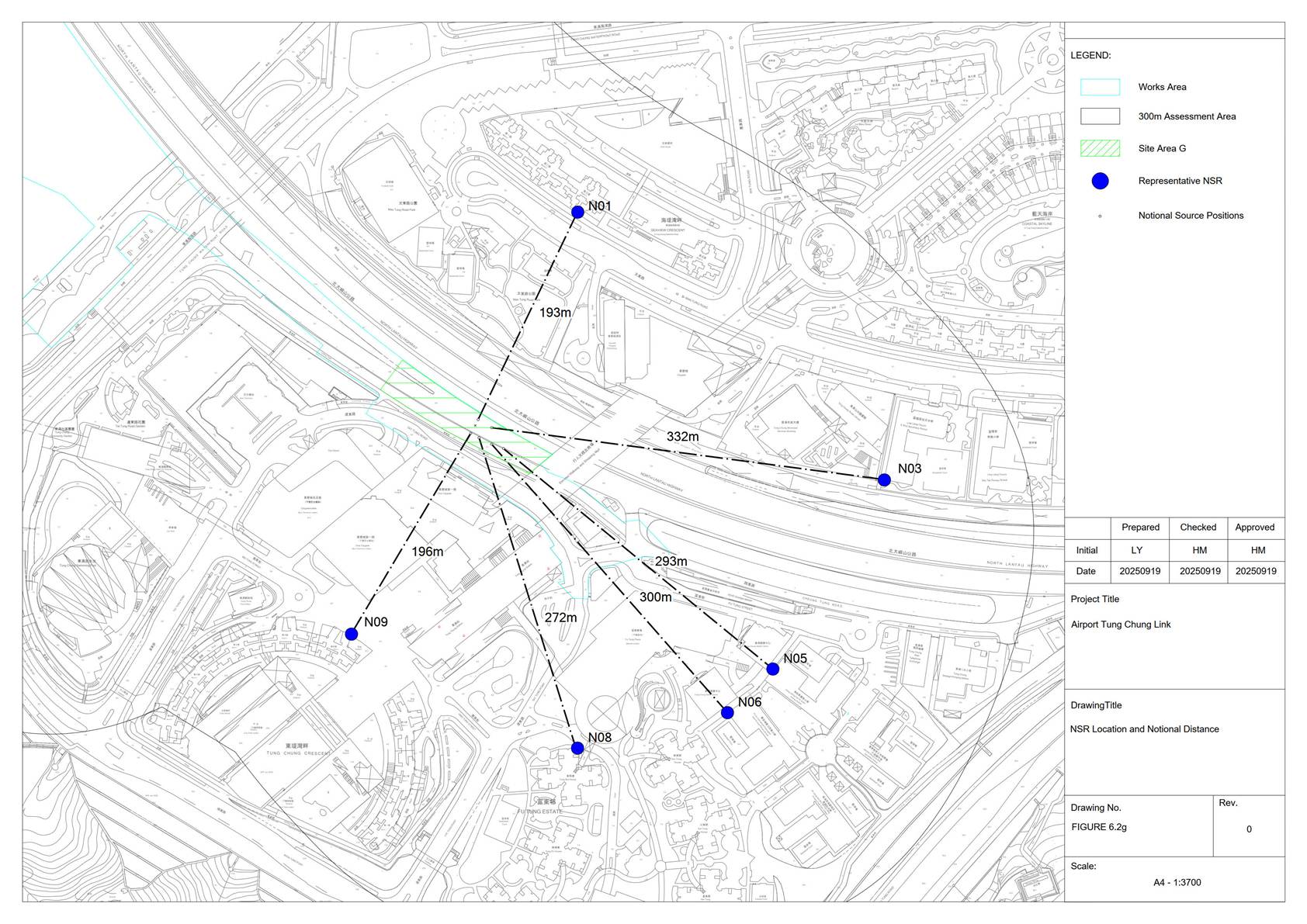

assessment area are presented in Table 6.1 and their locations are shown

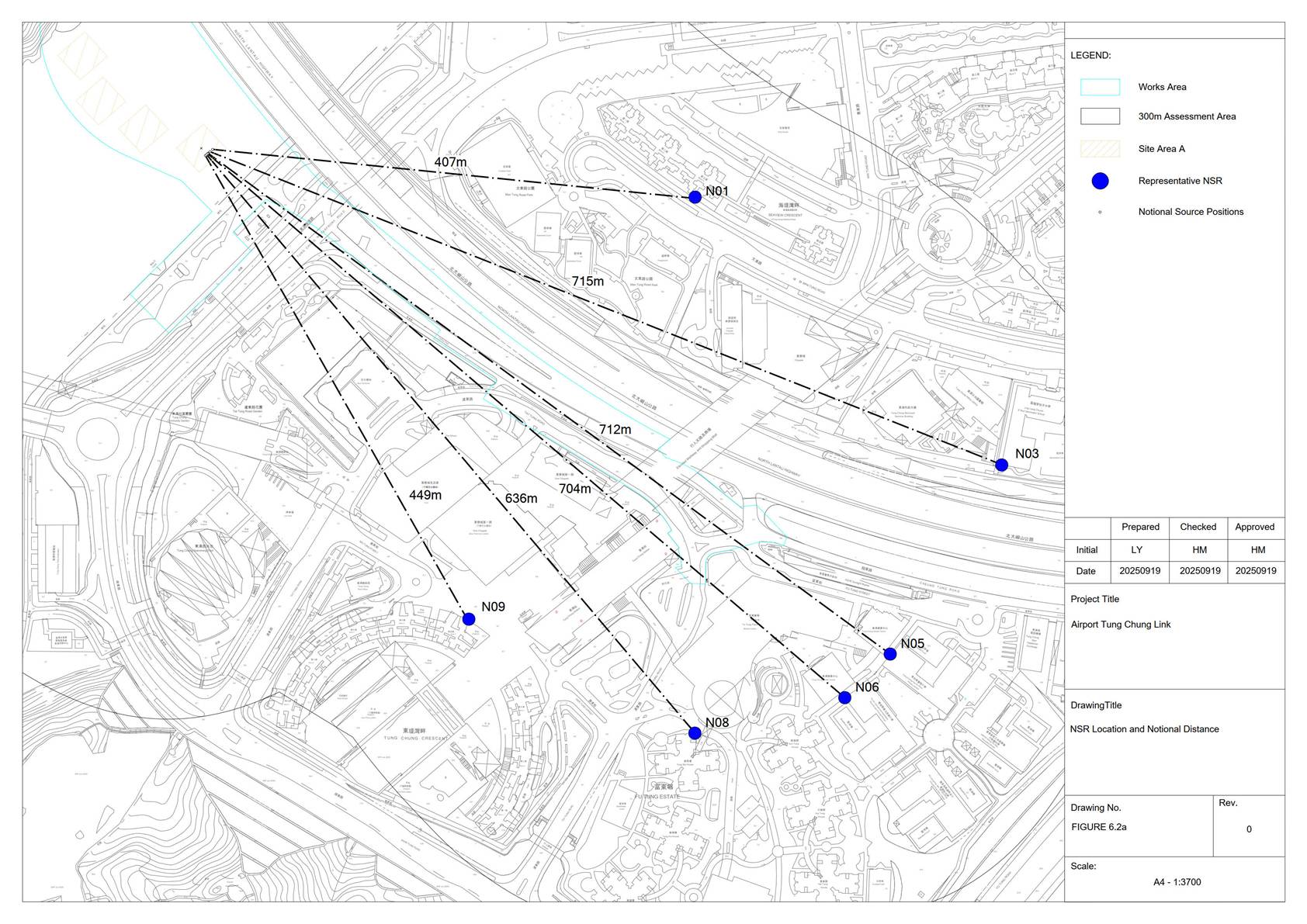

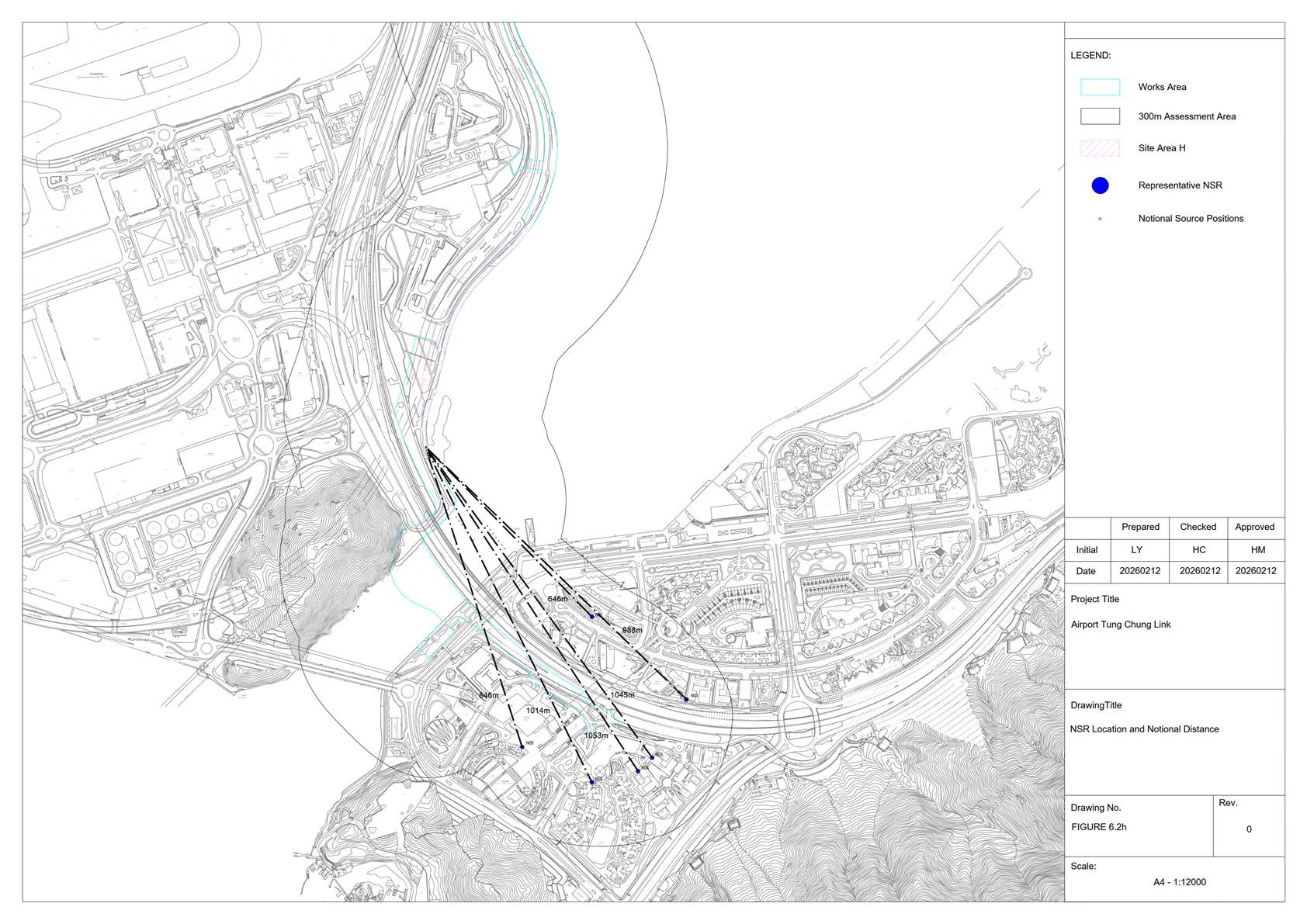

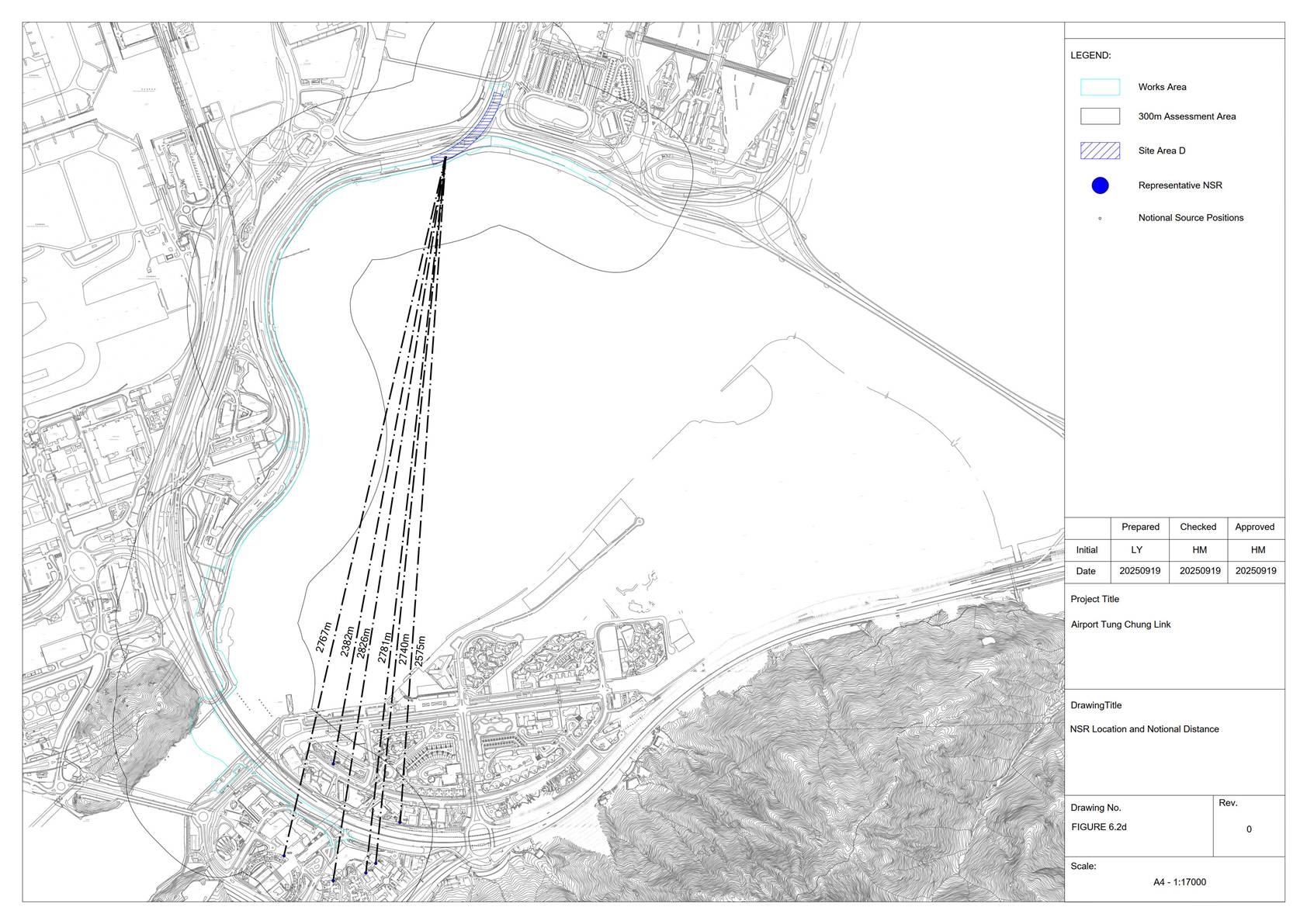

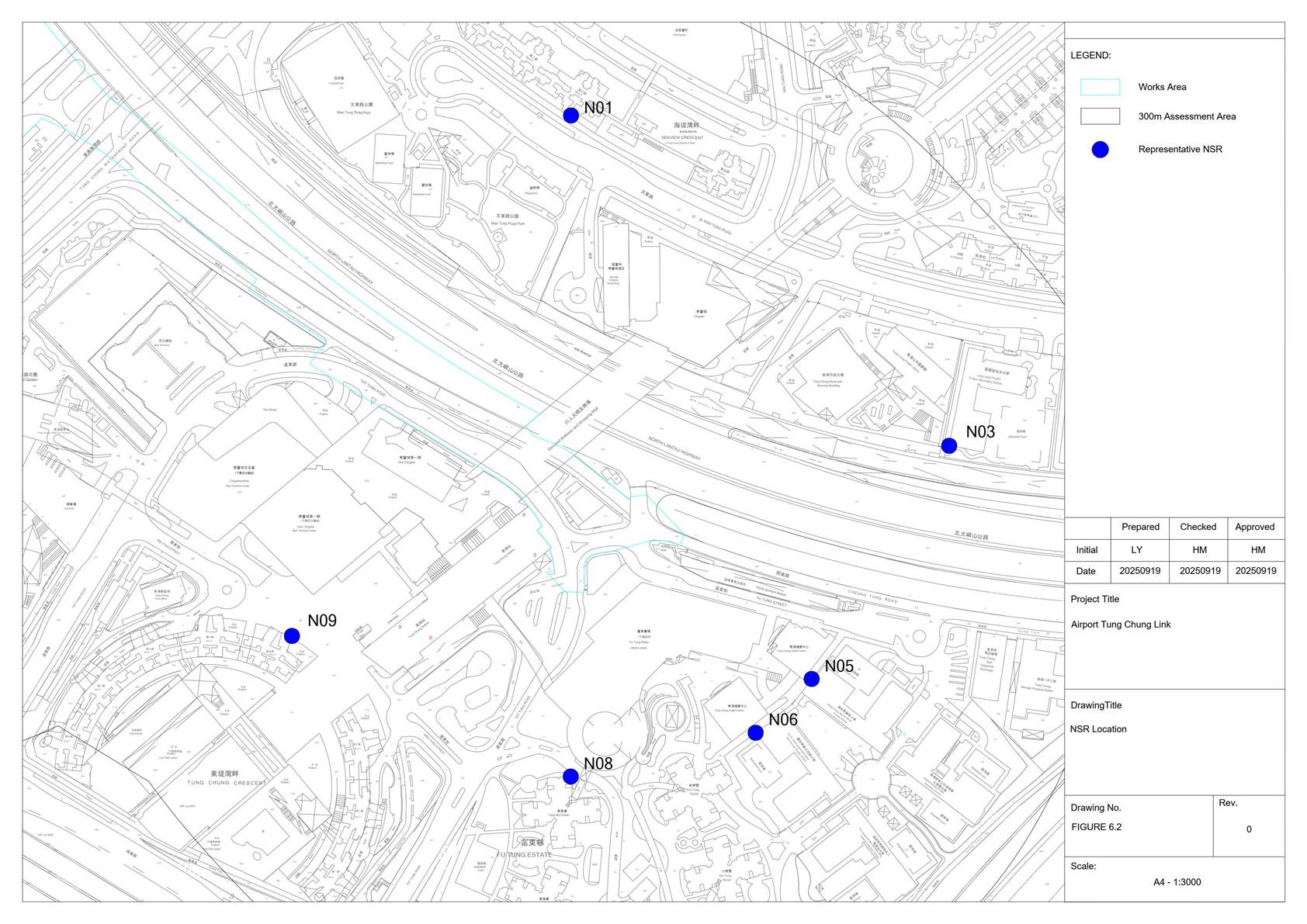

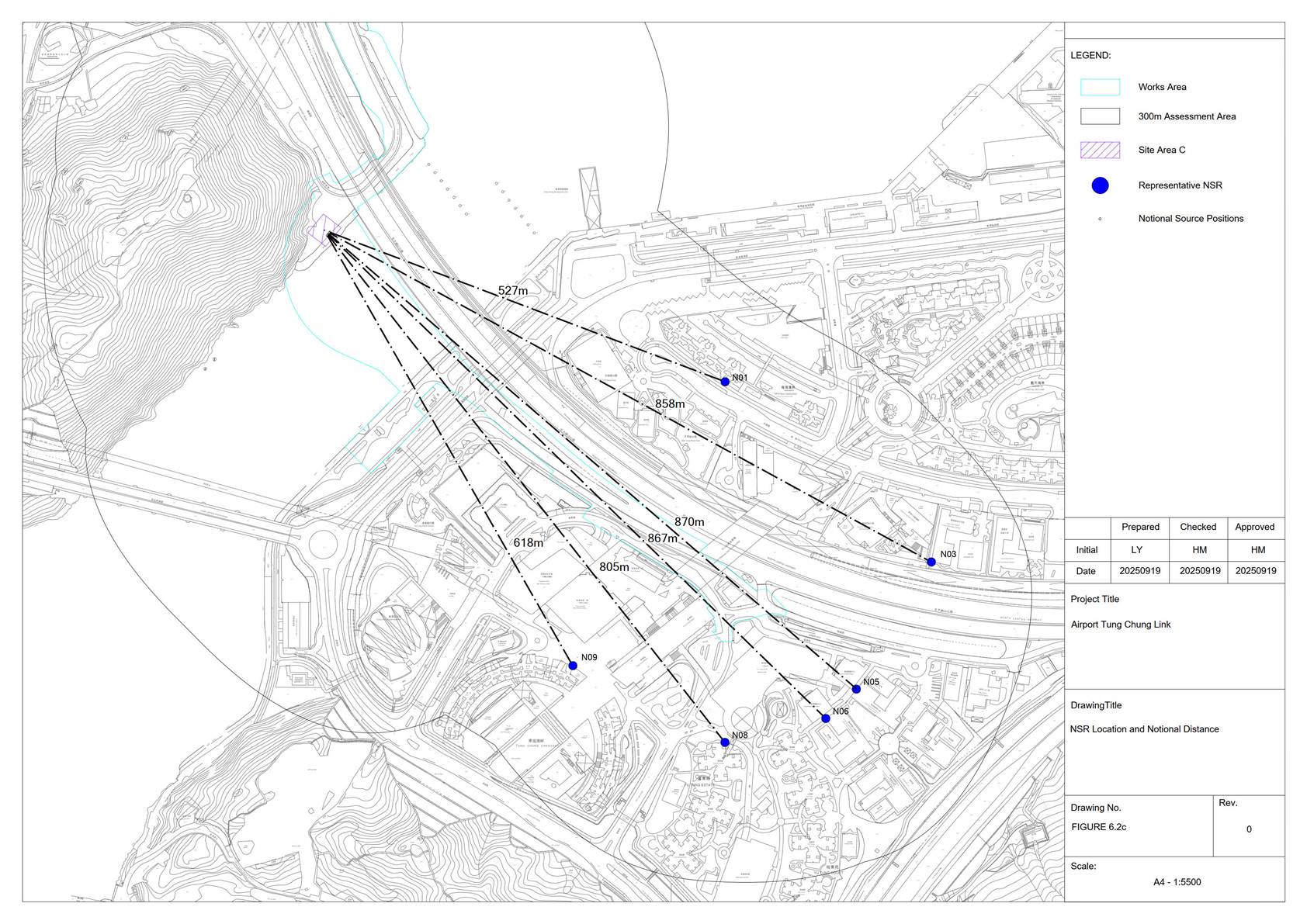

in Figure 6.2.
Table 6.1 Noise Sensitive Receivers (NSRs) Identified
|
NSR ID |
Description |
Uses |
Existing/
Planned |
|
N01 |
Seaview Crescent |
Residential |
Existing |
|
N03 |
Ling Liang Church E Wun Secondary School |
School |
Existing |
|
N05 |
Ching Chung Hau Po Woon Primary School |
School |
Existing |
|
N06 |
Po On Commercial Association Wan Ho Kan
Primary School |
School |
Existing |
|
N08 |
Fu Tung Estate |
Residential |
Existing |
|
N09 |
Tung Chung Crescent |
Residential |
Existing |
|
N10 [3] |
Priests’ Quarters of the Planned Visitation
Church Development |
Residential |
Planned |
Notes:
[1] The assessment
will only include NSRs which rely on opened windows
for ventilation.
[2] Only the first layer of NSRs has been selected for assessment.
[3] The tentative occupancy year of the
planned NSR (N10) is 2028; therefore, it is not included in the assessment in
this CNMP, and will be included in future CNMP as and
when appropriate.
Prediction and Evaluation of Construction Noise Impact (Unmitigated)
Potential source of noise
impact arising from the construction of the Project would be the use of Powered Mechanical Equipment (PME) for various construction activities. The percentage on-time for each PME has been estimated individually for
each construction activity to ensure practicality. The proposed construction
plant inventory is recommended by the Contractor and provided in Appendix B.
The proposed construction plant inventory in Appendix B is considered
technically feasible and confirmed by the Project engineer as workable, and would represent a realistic worst-case
scenario for assessment purposes. The unmitigated construction noise impacts at
the identified NSRs have been predicted accordingly. Details of unmitigated
construction noise assessment are presented in Appendix C with the

results summarized in Table 7.1.
The screening effect due to existing
structures/barriers nearby the Project Site such as Novotel Citygate Hong Kong,
Fu Tung Plaza, The Silveri and the noise barrier for Airport Express Line have
been considered in the prediction of construction noise levels. Where
appropriate, -10 dB(A) screening effect has been adopted in the construction
noise calculations. Further details can be referred to Appendix C and D.
For worst-case scenario, the noise mitigation
criteria for schools were set to 65dB(A) for all months. As shown in Table 7.1,
the construction noise levels at the identified representative construction NSRs
would range from 69 to 76dB(A) for residential use
and 61 to 69dB(A) for schools under the unmitigated scenario. The predicted
construction noise levels would comply the relevant
noise criteria except Seaview Crescent (N01), Tung Chung Crescent (N09) and Ling Liang Church E Wun Secondary School (N03) during
examination period.

Noise mitigation measures are therefore required to alleviate the construction
noise impact on the affected NSRs.

Table 7.1 Predicted Construction Noise Levels under Unmitigated Scenario
|
NSR ID |
Description |
Uses |
Predicted
Construction Noise Level, Unmitigated, Leq
(30mins), dB(A) |
Noise
Standards, dB(A) |
Noise
exceedance, dB(A) |
|
N01 |
Seaview Crescent |
Residential |
74-76 |
75 |
1 |
|
N03 |
Ling Liang Church E Wun Secondary School |
School |
65-69 |
65 |
4 |
|
N05 |
Ching Chung Hau Po Woon Primary School |
School |
61-65 |
65 |
0 |
|
N06 |
Po On Commercial Association Wan Ho Kan
Primary School |
School |
61-64 |
65 |
0 |
|
N08 |
Fu Tung Estate |
Residential |
69-72 |
75 |
0 |
|
N09 |
Tung Chung Crescent |
Residential |
74-76 |
75 |
1 |
Note:
[1] Cumulative noise
level of other concurrent projects had been considered for N09 Tung Chung
Crescent.
Concurrent Project and Cumulative Impact
The Railway Development Strategy 2014 (RDS-2014)
announced by the Government of the Hong Kong Special Administrative Region
included the conceptual scheme of Tung Chung West (TCW) Extension and a
possible Tung Chung East (TCE) Station. The works areas and construction programme of Tung Chung Line Extension have been reviewed

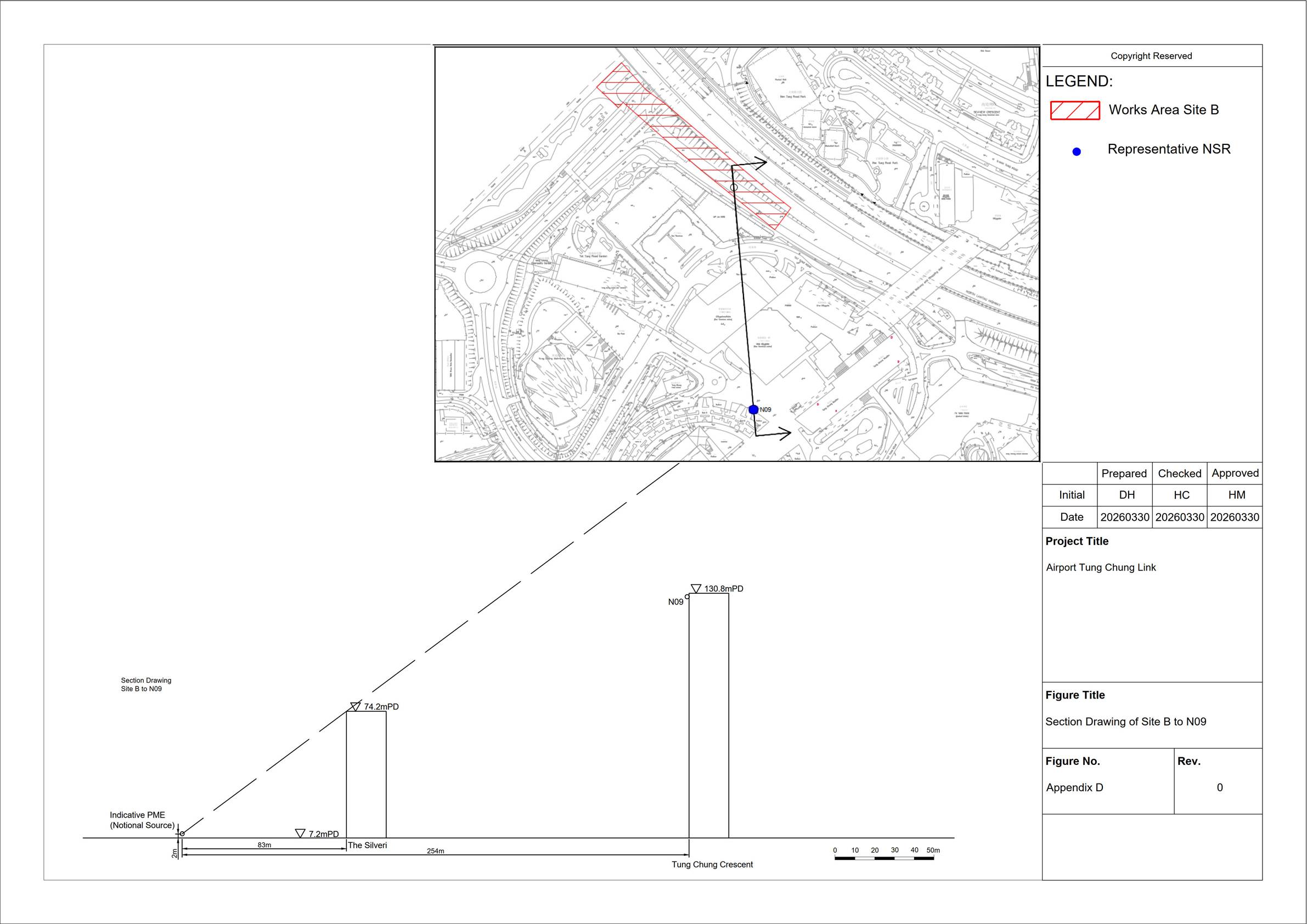

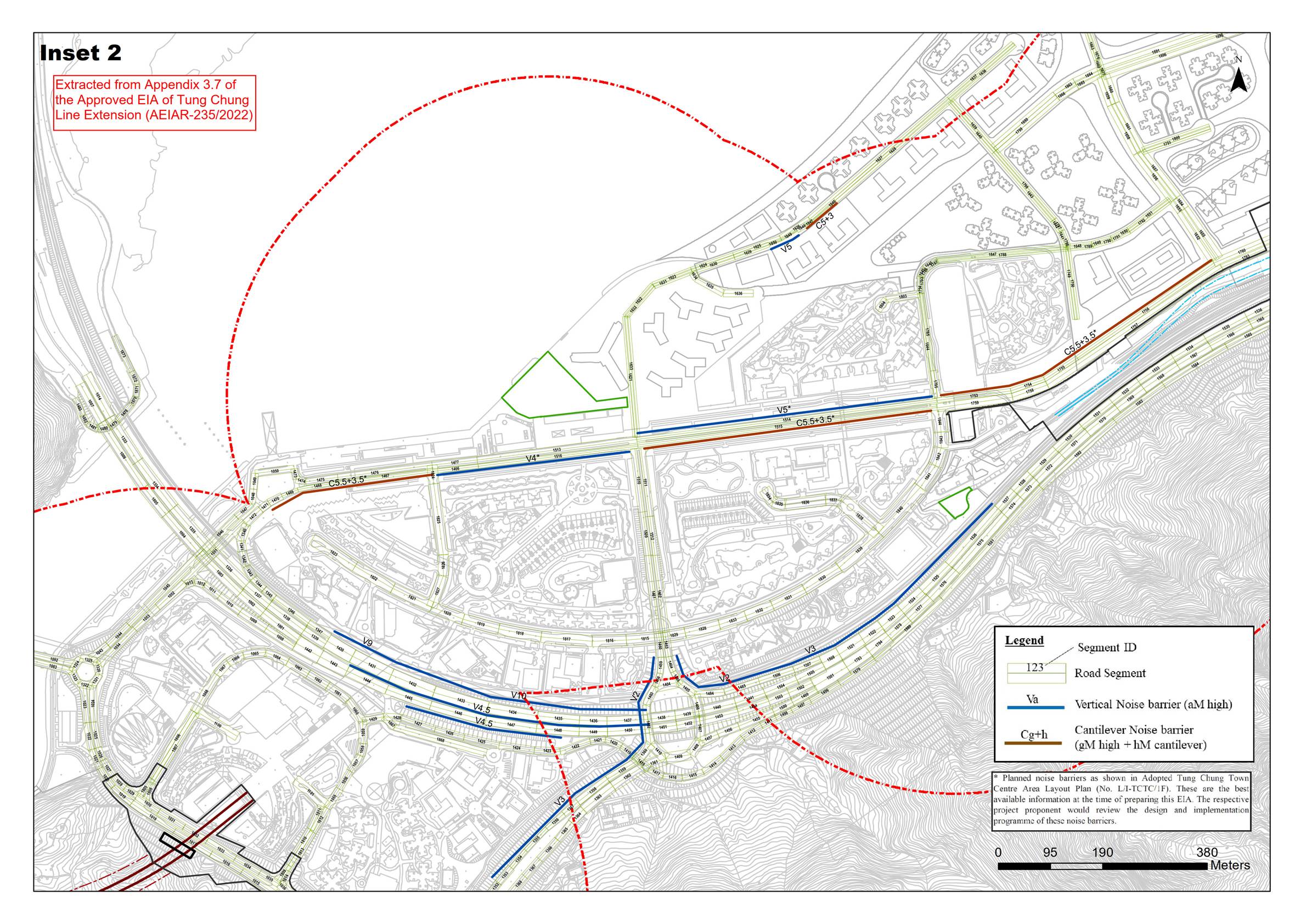

based on latest available information. The location of the concurrent project
is shown in Figure 6.1. According to Construction Noise Management Plan
(Jan 2026) for Works Contract 1201, their latest works areas and works sites
are within of 300m of the one of the NSRs (Tung Chung
Crescent) of this Project (Appendix H refers). It is noted that the
representative NSR at Tung Chung Crescent in this CNMP is facing away from the
construction site of Tung Chung Line Extension, a conservative construction
noise level from the construction site of Tung Chung Line Extension at Tung
Chung Crescent in Construction Noise Management Plan (Jan 2026) for Works
Contract 1201 had been adopted in cumulative assessment for conservative
approach. The cumulative construction noise impact from construction of Tung
Chung Line Extension is presented in calculation Appendix C.
It is noted that the sewerage upgrading work of the
Three Runway System (3RS) would be constructed near the TCCS and is expected to
commence no earlier than June 2026. The relevant information from the 3RS EIA
report on the sewerage upgrading work will be incorporated into future versions
of the CNMP as and when available.
Use of Quieter PME and Quality Powered Mechanical Equipment (QPME)
Taking into account the latest construction programme and PME
inventory provided by the Contractor, quieter PME for mobile crane, air compressor, generator and excavator are proposed as listed in Table 7.2. However, if the exact model
specified in the references/QPME labels of the listed quieter PME are not
available, or the QPME label has expired during the construction period, the
model with SWL not higher than the listed SWL shall be adopted.
Table 7.2
Quality PME Proposed for Adoption during
Construction Phase
|
PME |
Reference
[1] |
SWL,
dB(A) |
|
Mobile
Crane |
QPME:
EPD-12661 |
108 |
|
Air
Compressor |
QPME:
EPD-11726 |
100 |
|
Generator |
QPME:
EPD-12349 |
90 |
|
Excavator |
QPME:
EPD-16451 |
107 |
Note:
[1] The SWL is
prescribed in Quality Powered Mechanical Equipment (QPME) in
EPD website.
Quieter Construction Methods
The below quieter construction methods have been
considered and assumed to be applied in all construction works areas in the EIA
Report (AEIAR-254/2023). As advised by the Contractor, the methods shall be
applied construction works whenever applicable.
·
Hydraulic concrete crusher can be used for rock breaking activities
during site establishment, instead of traditional hydraulic breaker.
The operation principle of hydraulic breaker is by percussive striking actions
of its chisels, while hydraulic concrete crusher is by clamping action.
According to EPD website, the sound pressure level at 7m from the equipment is
67-69 dB(A). The Contractor advised that there are no
rock breaking in the construction works of entire
construction period, therefore, this method is not applicable. Nevertheless, if
there are any updates in the construction works that are relevant to the
specific quieter construction method, the method shall be re-considered
whenever applicable.
·
Non-explosive chemical expansion agent can be
used for concrete breaking activities during site establishment, instead of
traditional hydraulic breaker. The agent is a
slow-acting chemical compound and expand, and cracks
the structure. Significant noise, ground vibration, fly rock, gas, dust or any
other environmental pollution would not be generated during the process. The
Contractor advised that only road surface breaking is involved in the
construction works of entire construction period, no concrete breaking activities
are anticipated, therefore, this method is not applicable. Nevertheless, if
there are any updates in the construction works that are relevant to the
specific quieter construction method, the method shall be re-considered
whenever applicable.
·
Quieter type saw (e.g. diamond wire saw, diamond blade saw) is a
flexible sawing technique that can be applied under various situations with
excellent cutting performance. It will
be used instead of excavator-mounted breaker for site formation and road works
as far as practicable, subject to actual site conditions. According to the EPD
website, the sound pressure level at 7 meters from the quieter type saw is 76-81 dB(A). As a conservative approach, both
quieter type saw and excavator-mounted breaker have been included in the
construction noise calculation.
·
Self-compacting concrete can be used for concreting works, instead of
traditional vibratory poker. Self-compacting concrete is highly fluid and non-segregate,
which can spread into place, fill the formwork, and encapsulate the steel bar
reinforcement without using vibratory poker or other PME. The Contractor
advised that the use of self-compacting concrete in bore piles poses
significant challenges in quality control due to the risk of segregation (separation
of components) or bleeding (water rising to the surface), therefore, this
method is not applicable.
·
Silent piling by Press-in Method (Press-in piling) can be used for sheet
piling works, instead of traditional massive augering
and piling machines (e.g.: Piling, vibrating hammer). Press-in method is a pile
penetration method which accurately installs pre-formed piles through static
loading piling. The construction work can also be completed in shorter duration
so that the noise impact to nearby NSRs can also be further alleviated.
According to the EPD website, the sound pressure level at 7 meters from the
equipment is 69 dB(A). The Press-in method would be applied during piling works
at TCCS.
·
Use of pre-casting and prefabrication technology, such as precast
concrete blocks will be applied in seawall construction to reduce on-site
construction work.
Use of Noise Barrier, Noise Enclosure and Noise Insulating Fabric
Proprietary noise barriers (SilentUp)
will be used for screening noise to NSRs and could achieve an insertion loss of
22 dB(A). 3.5m(H) noise barrier shall be provided for the piling, large

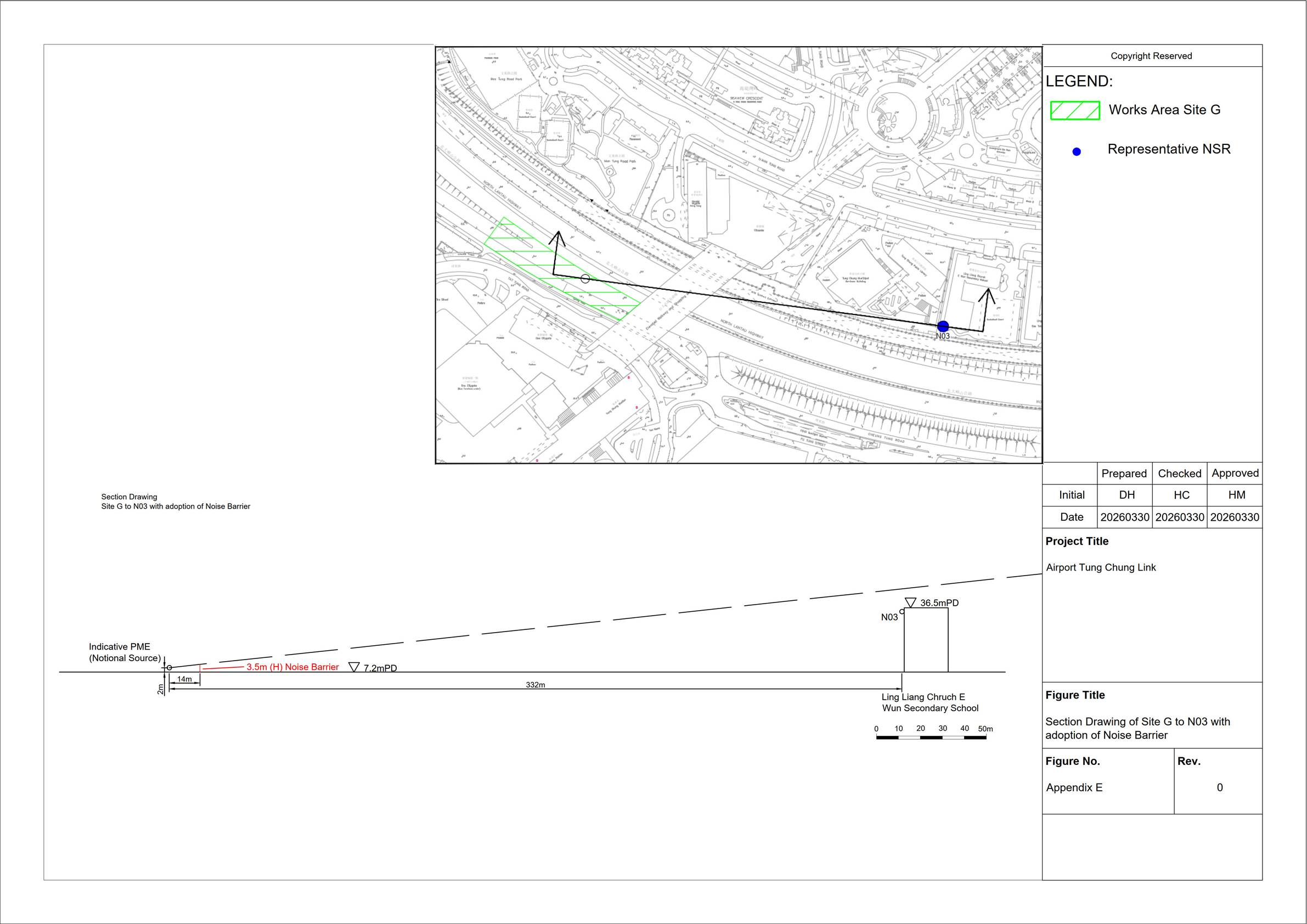

diameter bored, oscillator at Site G to block the direct line-of-sight to N03.
The noise barrier should be placed as close as practicable to the PME intercepting
the direct line-of-sight between NSR and PME such that the noise barriers are
capable to shield the PME from the NSR completely. The catalogue and schematic
drawing of noise barrier is shown in Appendix E. Gaps and openings at
joints in the barrier material should be avoided. The barrier should also be
long enough to minimize the degradation caused by the diffraction along the
short edges. With reference to EIAO Guidance Note No.9/2023, noise reduction of
5dB(A) and 10dB(A) can be achieved by noise barriers for movable and stationary
plant respectively. Following the assumptions in the Approved ATCL EIA Report,
it is anticipated that suitably designed movable barriers/acoustic sheet
barriers could achieve at least 5 to 10 dB(A) reduction. For a conservative
assessment, only a reduction of 5 dB(A) is assumed.
Other noise mitigations such as noise enclosure and
noise insulating fabric shall be considered if necessary.
Use of Soundproof Hammer Bracket for Hydraulic Breaker
Soundproof hammer
bracket will be installed to reduce the noise from
hydraulic breaker. According to the Best
Practice Guide for Environmental Protection on Construction Sites, hammer bracket can achieve 10dB(A) noise reduction. The mitigation will include tuned
mass dampers installed on the breaker head; tailored breaker cloth wrapped
around the breaker head (minimum 7kg/m2 surface density); and noise
mitigating plastic skirt wrapped around the chisel tip of the breaker.
Prediction and Evaluation of Construction Noise Impact (Mitigated)
The implementation schedule of proposed mitigation

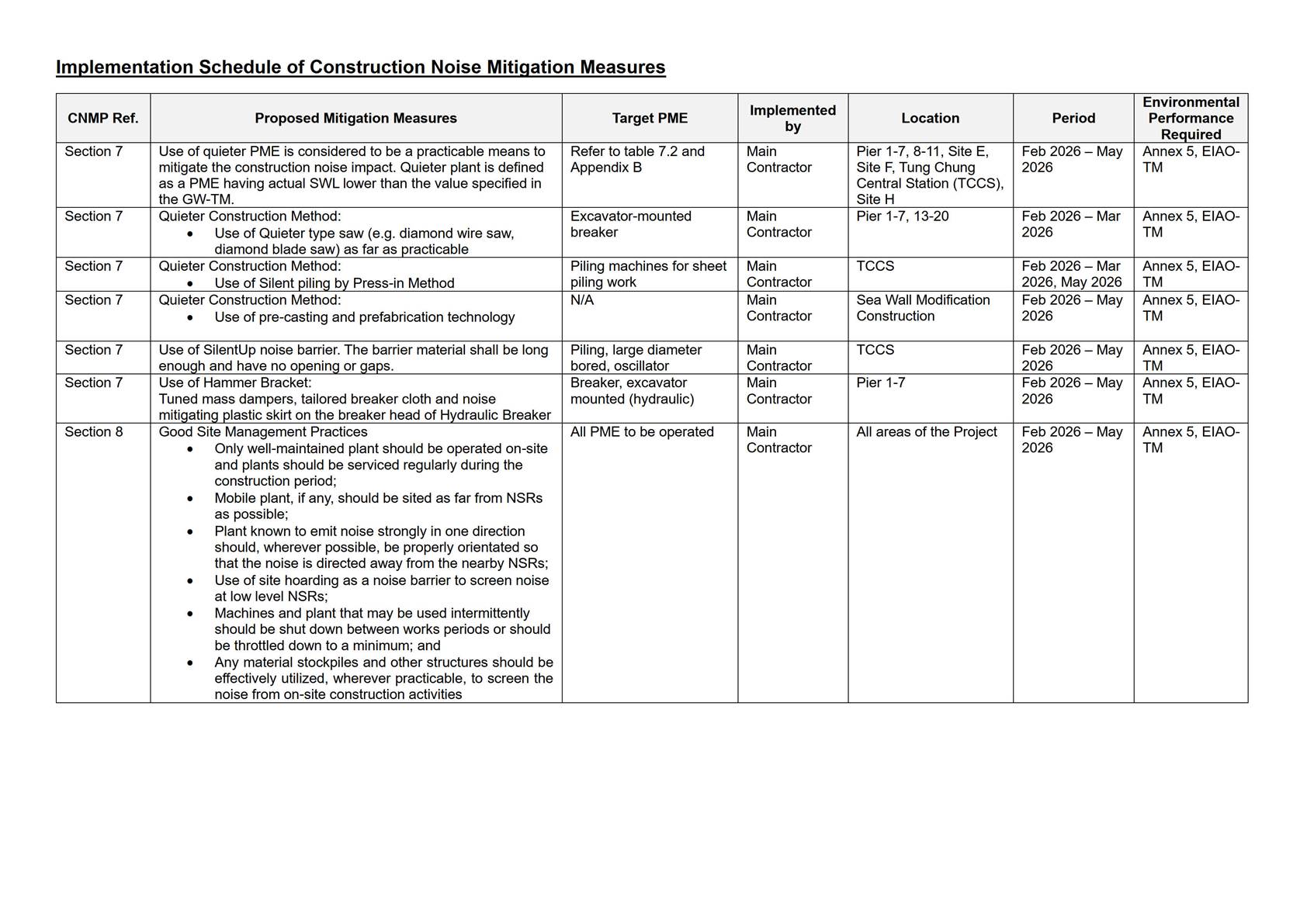

measures is shown in Appendix G. With the implementation of noise
mitigations, the predicted construction noise levels at representative
construction NSRs have been predicted and presented in Appendix F with
the results summarized in Table 7.3. The relevant construction plant
inventory could be referred to Appendix B.
Table 7.3
Predicted Construction Noise Levels under Mitigated
Scenario
|
NSR ID |
Description |
Uses |
Predicted
Construction Noise Level, Mitigated, |
Noise
Standards, dB(A) |
Noise
exceedance, dB(A) |
|
N01 |
Seaview Crescent |
Residential |
71-73 |
75 |
0 |
|
N03 |
Ling Liang Church E Wun Secondary School |
School |
63-65 |
65 |
0 |
|
N05 |
Ching Chung Hau Po Woon Primary School |
School |
59-63 |
65 |
0 |
|
N06 |
Po On Commercial Association Wan Ho Kan
Primary School |
School |
59-63 |
65 |
0 |
|
N08 |
Fu Tung Estate |
Residential |
66-69 |
75 |
0 |
|
N09 |
Tung Chung Crescent |
Residential |
73-75 |
75 |
0 |
With the implementation of proposed noise
mitigations, the predicted construction noise level would comply with the
relevant noise criteria, adverse construction noise impact would not be
anticipated.
This CNMP has identified the noise source inventory
and assessed the necessity of construction noise mitigation measures, including
the use of quality powered mechanical equipment, noise barriers and noise
enclosures for works at ATCL project. With the implementation of the proposed
noise mitigations and recommended good practices, noise impacts during
construction phases are expected to achieve full compliance of relevant noise criteria.
This CNMP focused on the construction works conducted during Feb 2026 to
May 2026 only and the remaining construction period is subject to change. The
Contractor will submit other CNMP reports for the remaining construction period
once the details become available. If there is any update on the construction works conducted from Feb 2026 to May 2026, a revised CNMP
will be submitted to the EPD.

![]()
